The slated roof in daylight with flush solar panels and rooflights, black vertical timber cladding to the side wall and the gable battened out around two windows
Shepperton, Surrey

Black House

New build to passive-house principles, in progress

Black House is a new build house whose garden backs on to the River Thames, designed by The Vawdrey House and built by Omniform to passive-house principles. It is on site now. This page follows it month by month until the house is finished.

The fabric is the point. Screw-piled foundations with a course of thermal blocks under every external wall. A beam and block floor over a ventilated undercroft. A steel frame with timber infill, mineral wool in every bay, and a taped airtight board layer with a target of 1 air change an hour at 50 pascals, blower-door tested during the build rather than just at the end. The certified test in September, at second fix, came in at 0.88 m³/h/m² at 50 pascals, about 0.9 air changes an hour. Heating and hot water come from an air source heat pump through underfloor circuits. A heat recovery ventilation unit keeps fresh air moving all year. Sixteen solar panels sit integrated into the slate roof with a battery behind them. Lime plaster throughout, left unpainted, on a site where spray foams and added-formaldehyde boards are banned to protect indoor air quality.

Until September the whole build ran inside a sheeted scaffold enclosure, so the structure went up dry. What you see below is what our sites look like.

Design: The Vawdrey House

New build home construction, and how we work with architects.

Before

The original bungalow

The original white weatherboard bungalow, seen square-on across its garden
The original weatherboard bungalow, its garden running down to the Thames. The scheme takes it down entirely, foundations and all. Everything after this photograph is new.
January 2026

Demolition and clearance

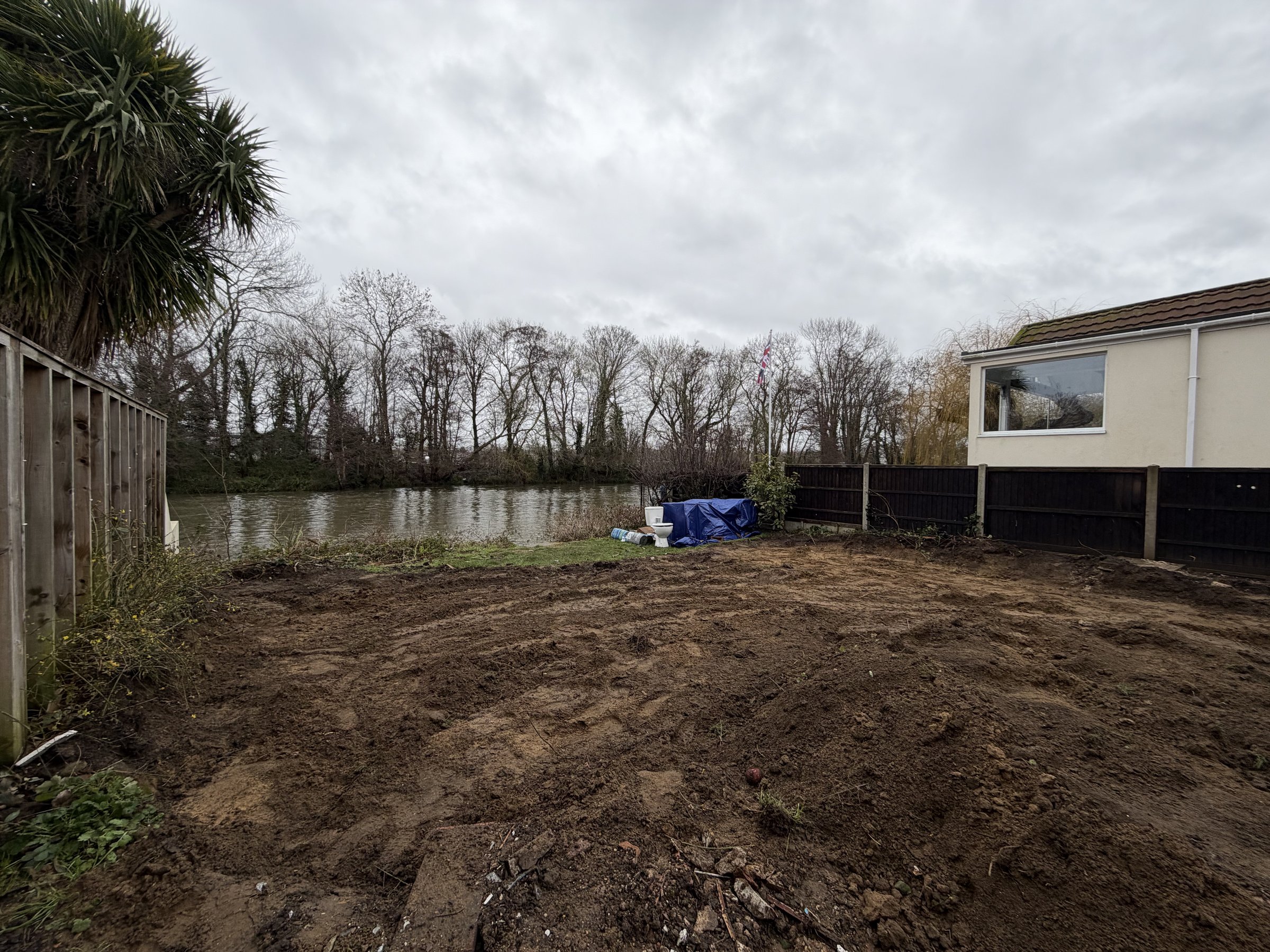

The cleared riverside plot running down to the water
The bungalow gone, its below-ground structures and drainage with it, and the plot cleared to the river’s edge.
February 2026

Piles and ground beams

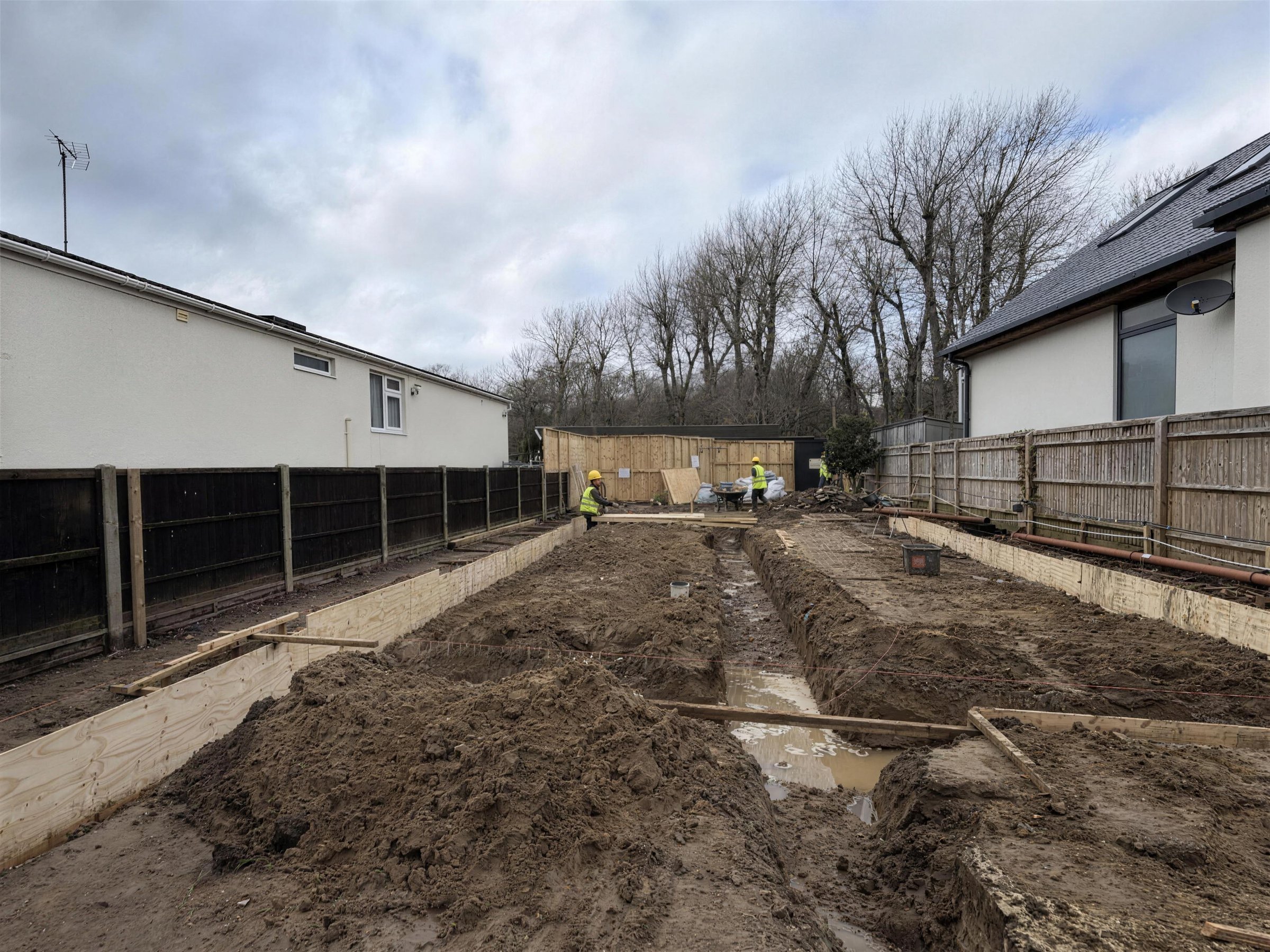

Excavated plot with plywood shuttering set up for the ground beams and the central trench dug to line
Shuttering going in for the ground beams. The plywood forms the sides of each beam, and the beams sit on the pile caps and span between them, tying the screw piles into one frame before anything is built off it.

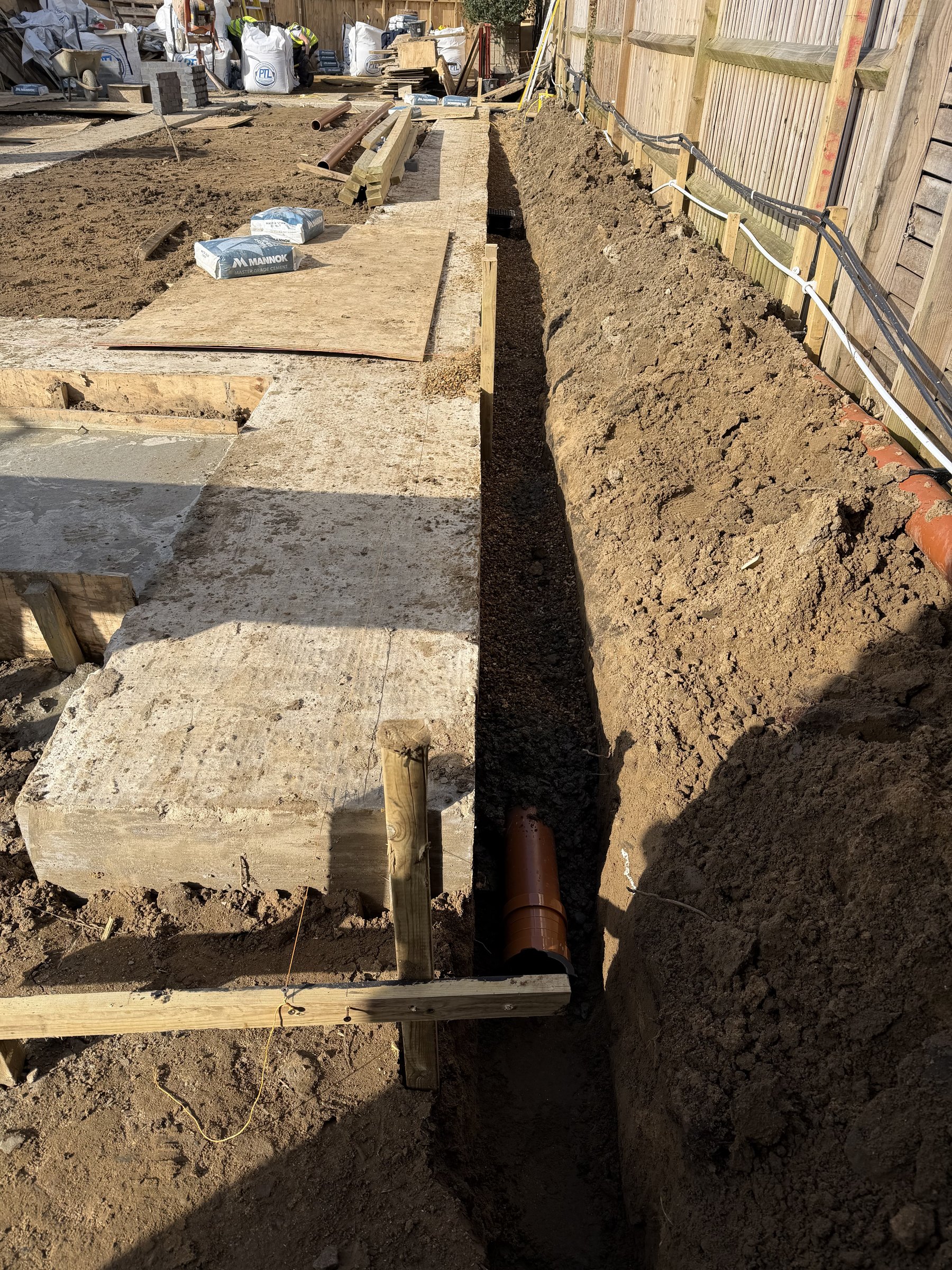

Cast concrete ground beam with a drainage run bedded in gravel alongside it
A ground beam cast, with new below-ground drainage bedded in gravel alongside it. The screw piling underneath was designed by our specialist.
March 2026

The sub-floor, built under cover

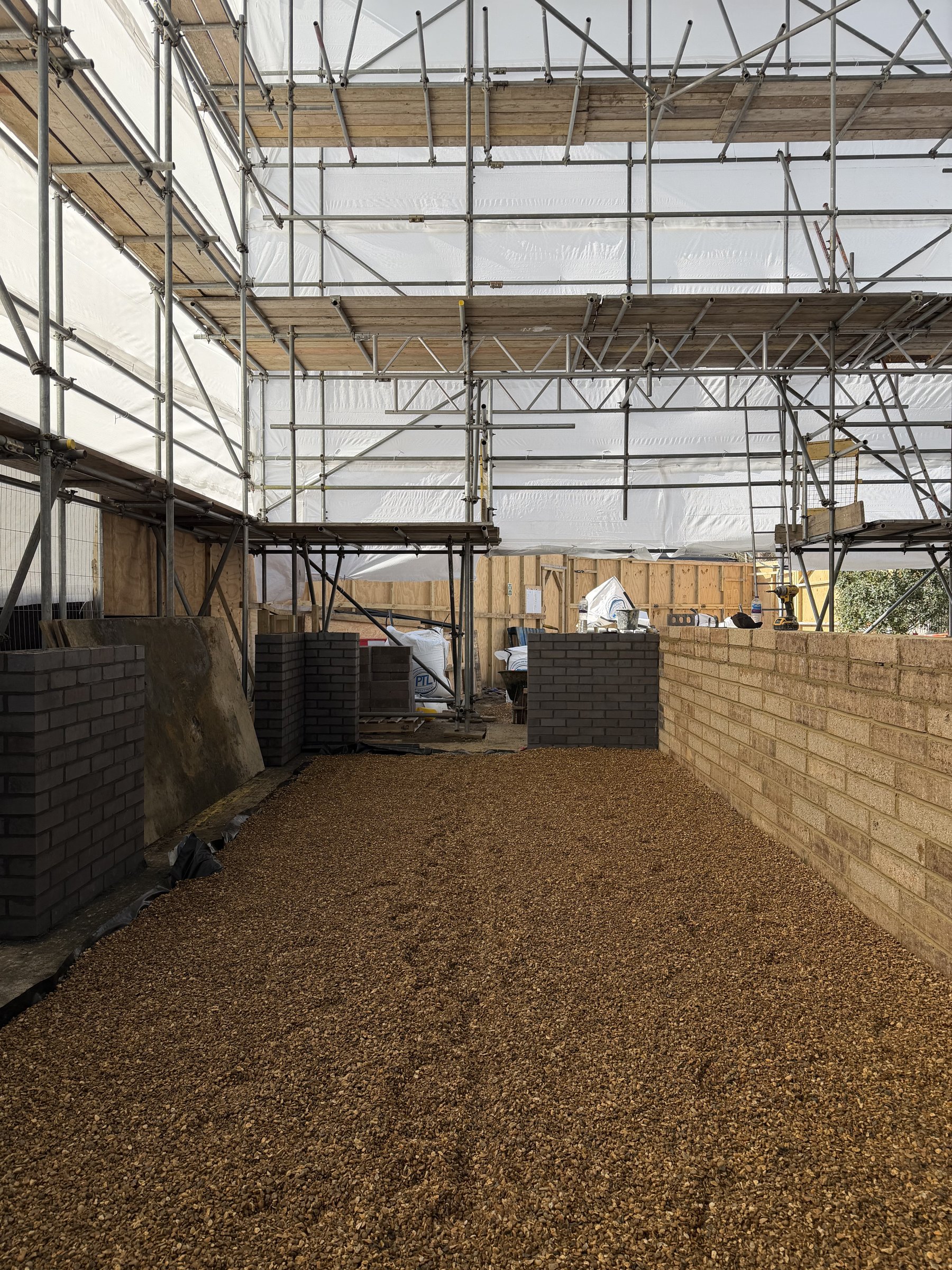

Brick plinth walls rising inside a fully sheeted scaffold enclosure
Loadbearing brick plinth walls rise off the piled foundations inside a fully sheeted scaffold enclosure. The house goes up dry.

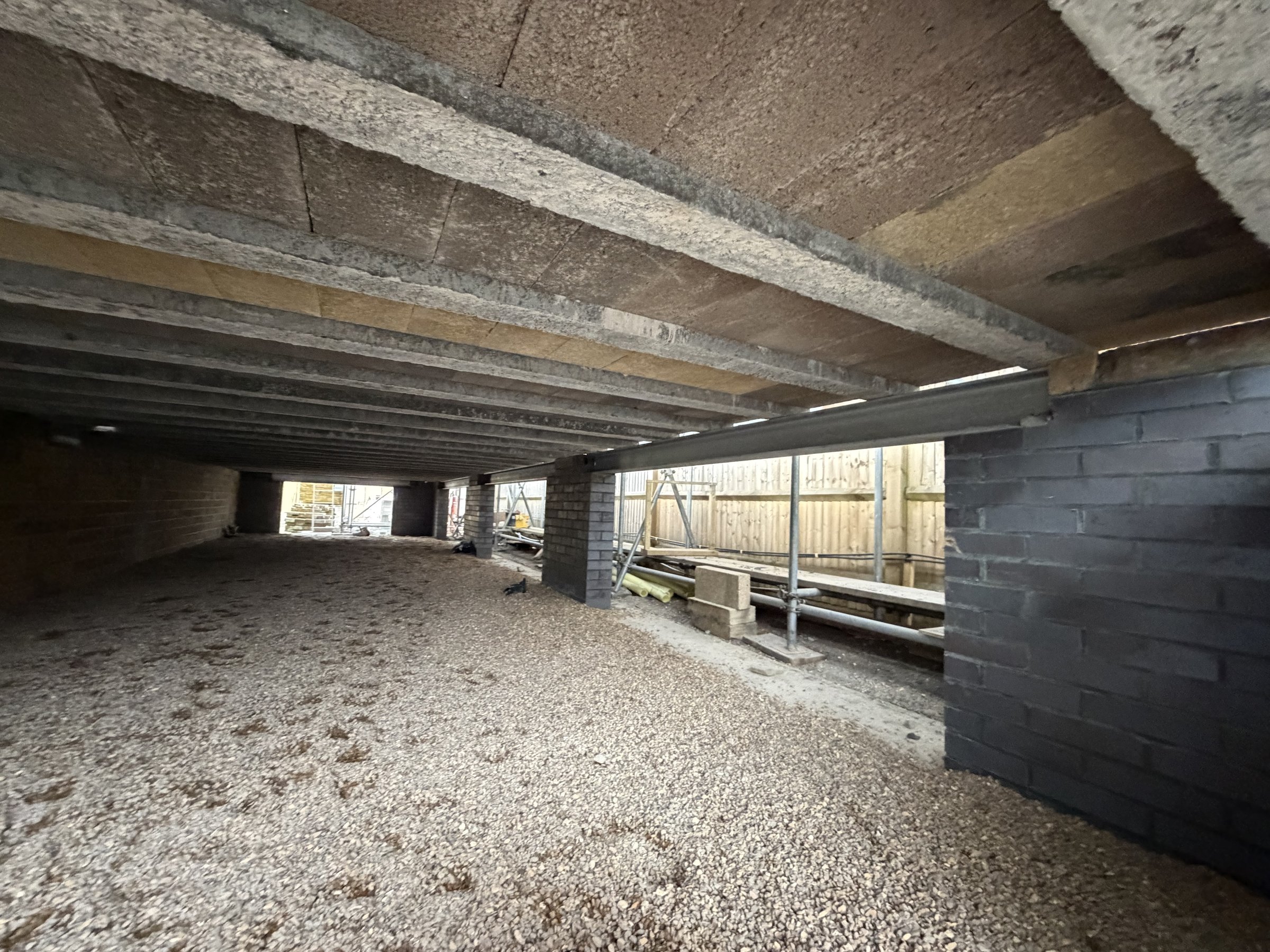

Beam and block floor on a galvanised steel frame over the plinth walls
The ventilated undercroft. A beam and block ground floor carried on a galvanised steel frame over the plinth walls.

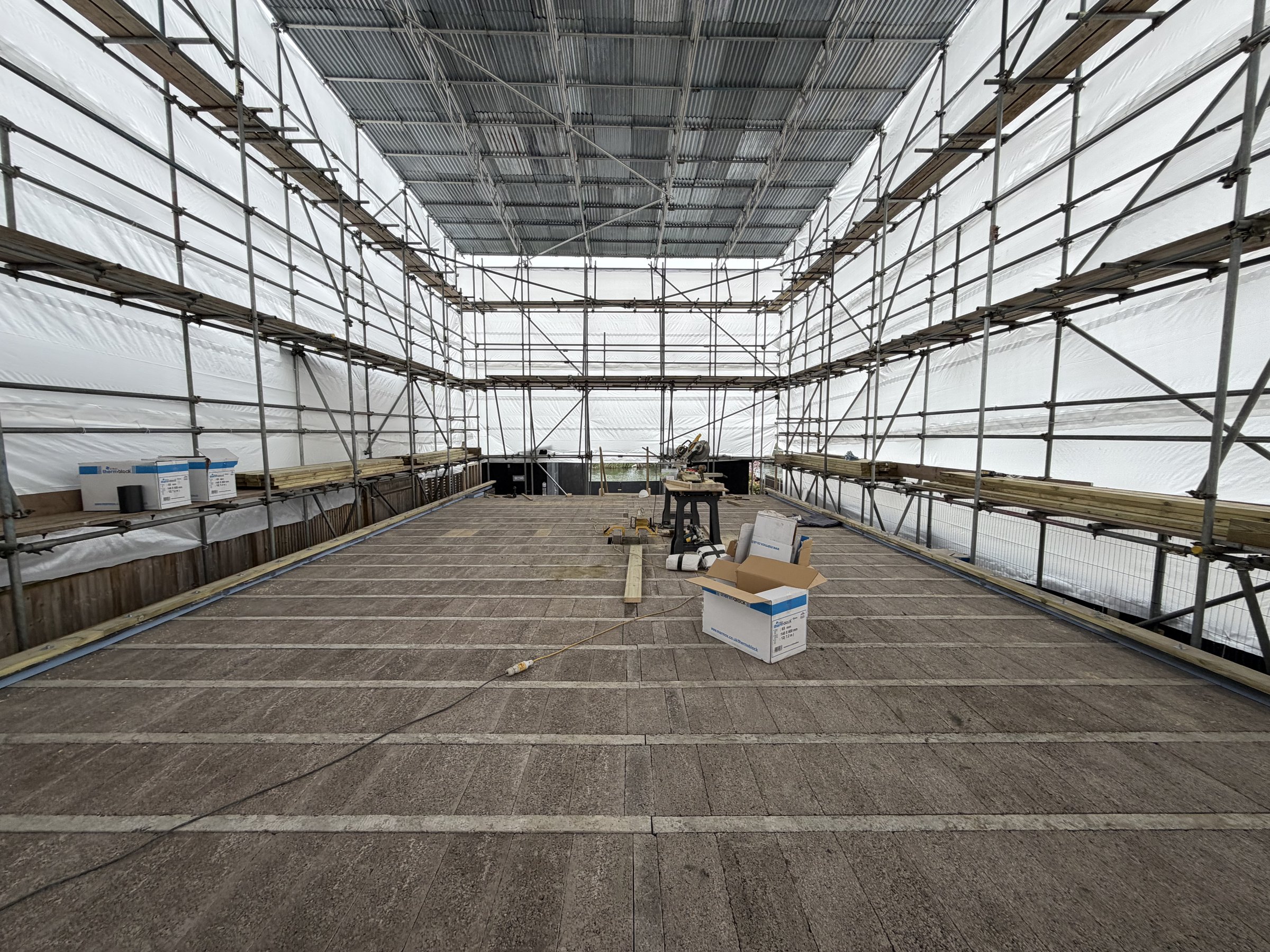

Thermal block kickers staged on the ground floor deck inside the enclosure
A course of thermal blocks under every external wall, laid to the whole floor perimeter with a DPC over. Cold bridging is designed out before the frame goes up.
April 2026

Frame, roof, and the airtight layer

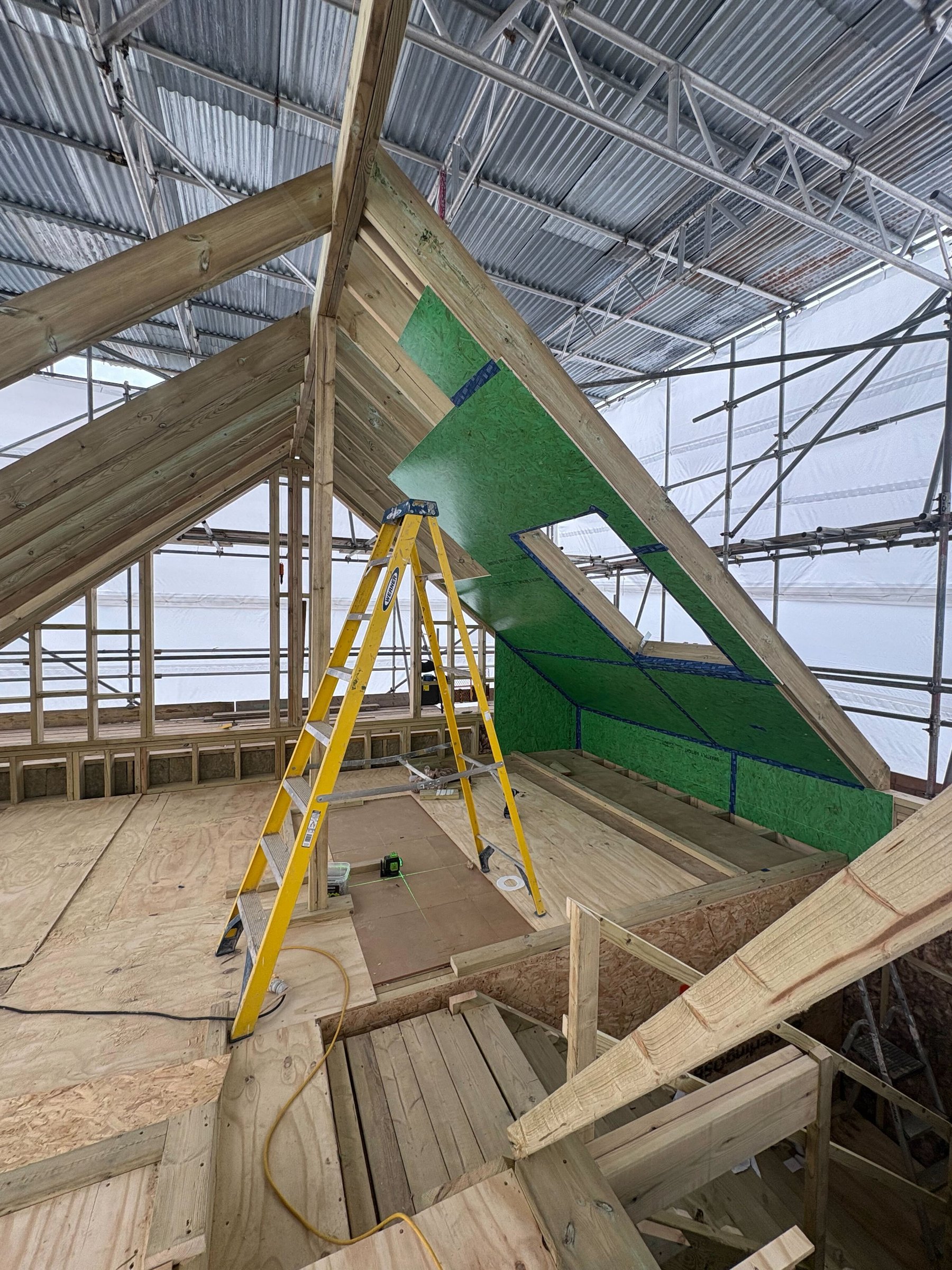

Roof structure with a dormer sheathed in green airtight board
A steel frame with timber stud and rafter infill forms the walls and roof, dormers already sheathed in airtight board.

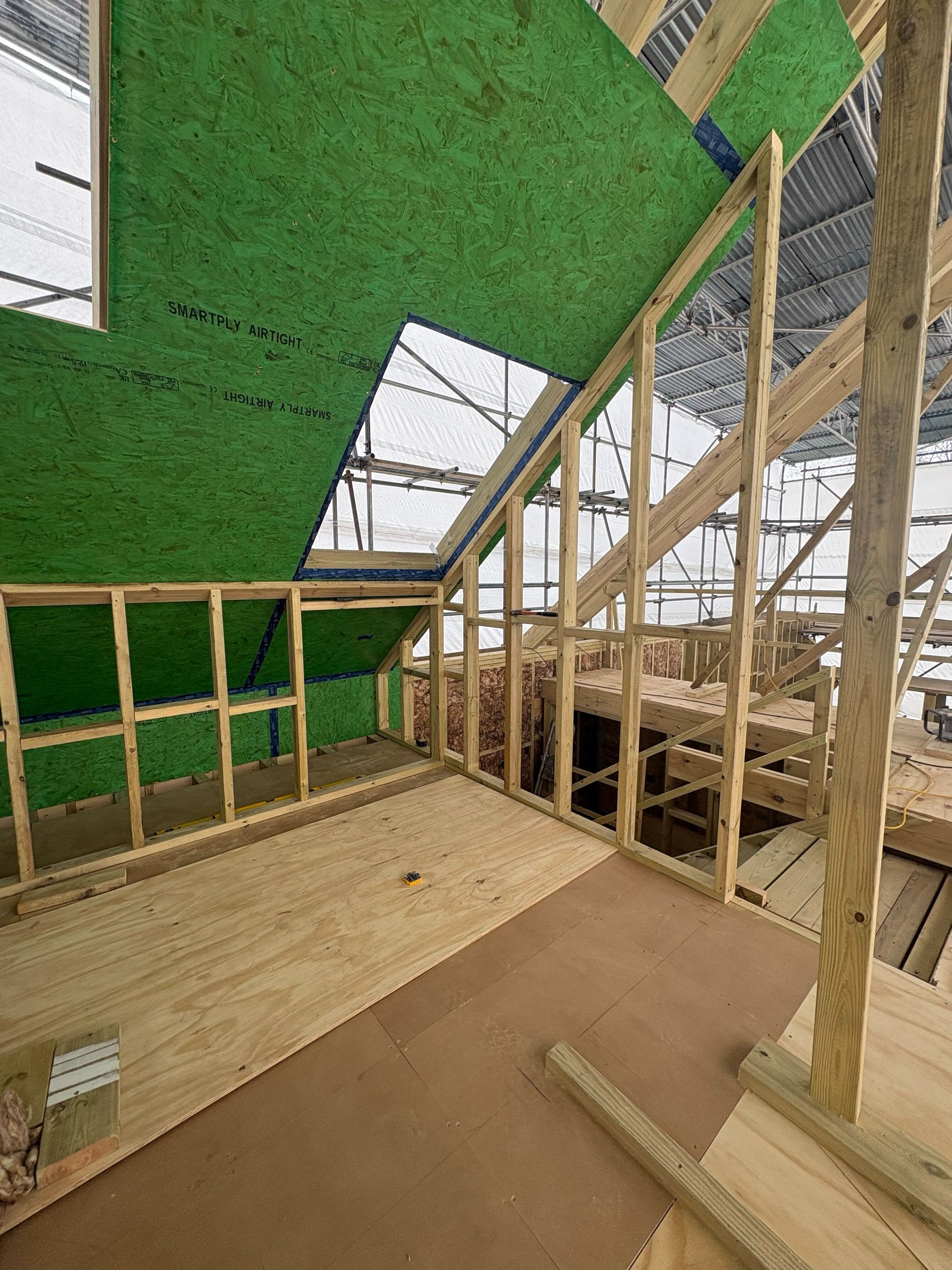

SmartPly Propassiv panels taped at every joint at the dormer
The airtight layer is part of the structure: SmartPly Propassiv board to the inside face of the studs, every joint and penetration taped. The target is 1 air change an hour at 50 pascals, checked with blower-door tests during the build, not just at the end.
May 2026

Underfloor heating

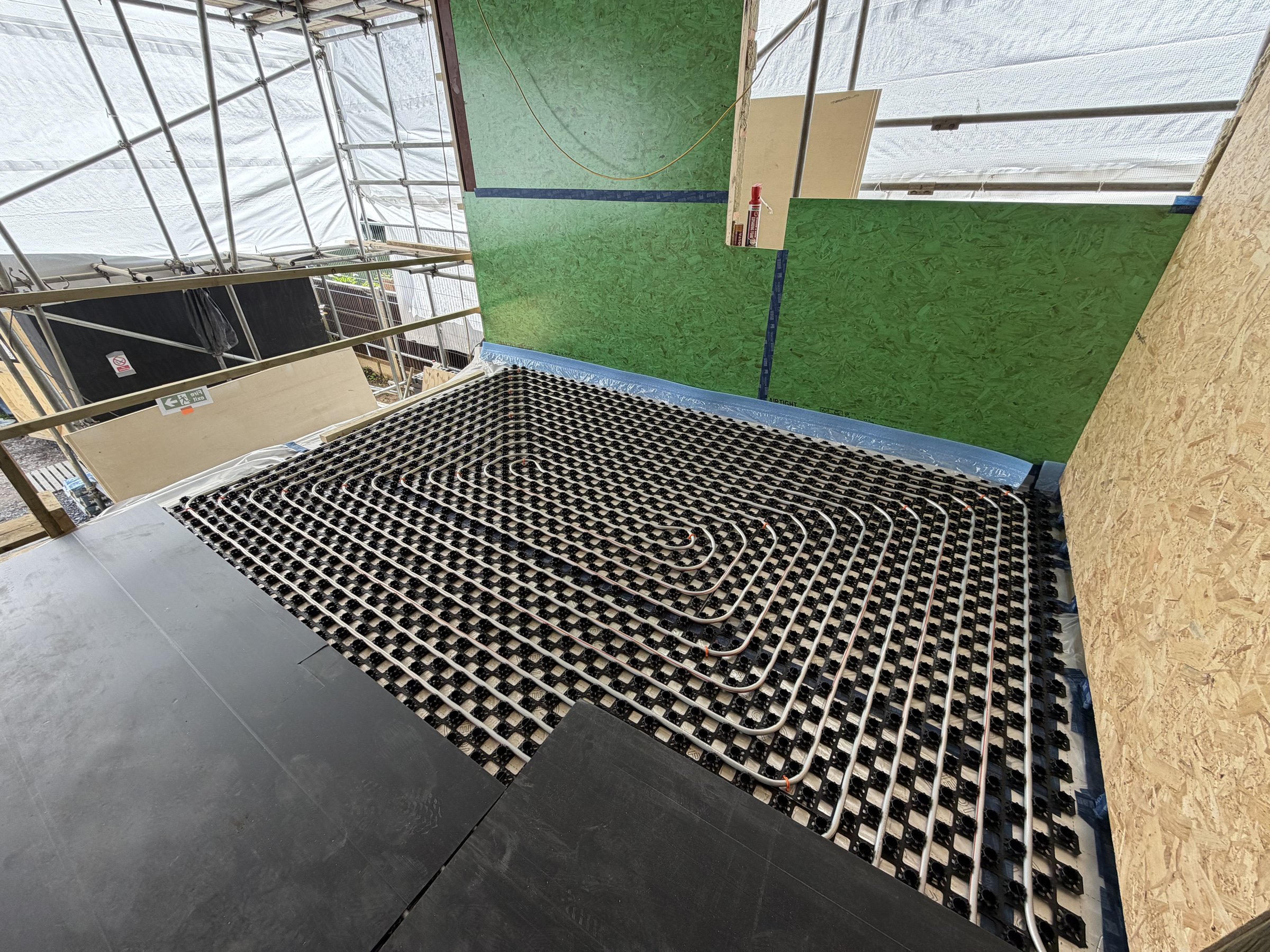

Underfloor heating pipework clipped over castellated overlay panels
Low temperature underfloor heating clipped over the castellated overlay panels, the taped airtight wall running behind. The heat pump will run it barely warm, all day.

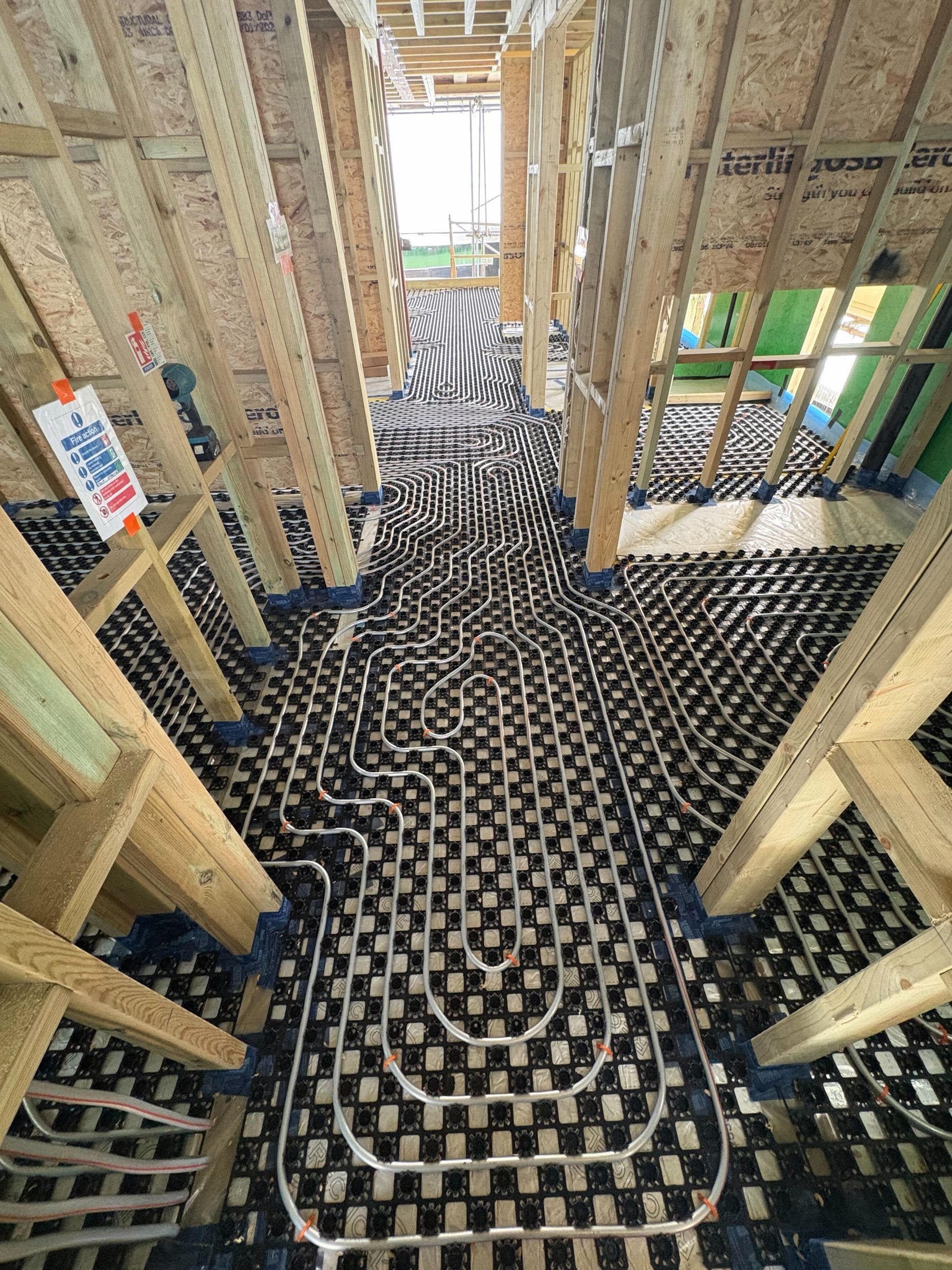

Heating pipe runs threading room to room through the timber frame
Heating circuits thread room to room through the frame: in-screed coils to the ground floor, overlay panels to the floor above.
June 2026

Taping, battens, first fix

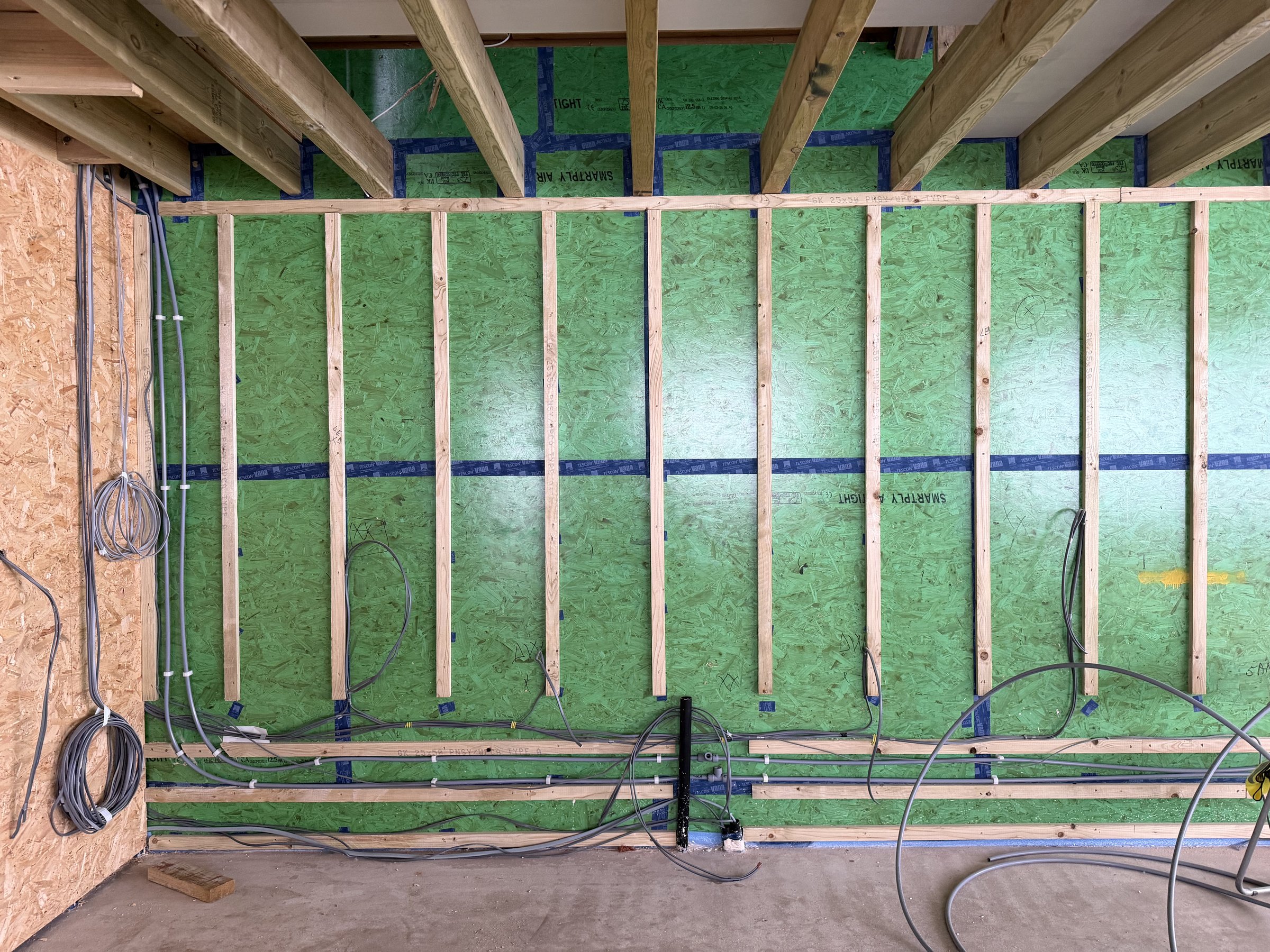

Airtight sheathing taped at every joint with a tape collar around each ceiling joist, first-fix cables clipped to battens below
Every sheathing joint taped, and a tape collar around each joist where it passes through the airtight line. First-fix cables run on battens in front of the boards rather than through them, so the layer stays intact once the electrician has been.

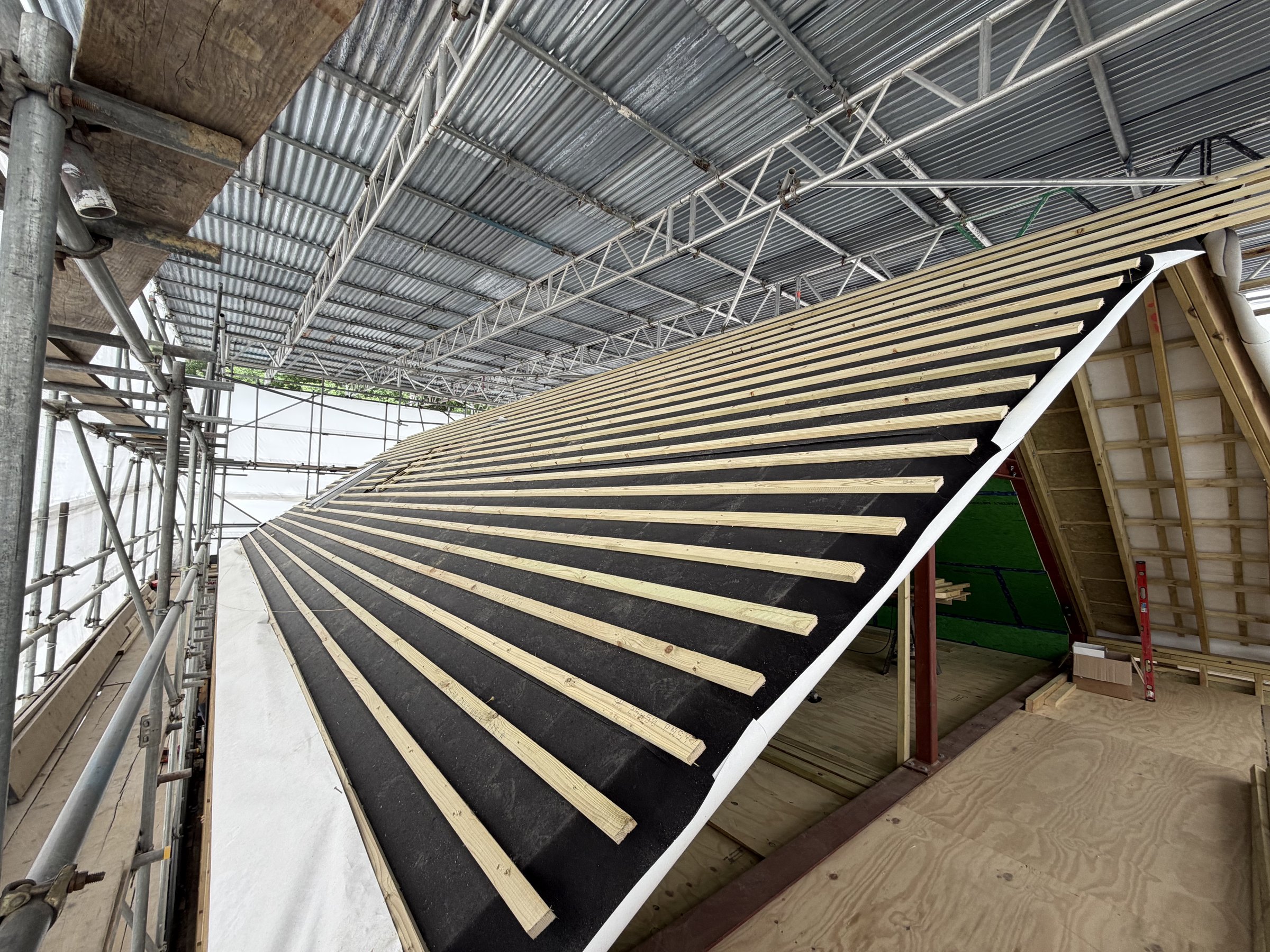

Counter battens and tile battens over dark breather membrane under the scaffold canopy
Counter battens and tile battens over the breather membrane, ready for slate. A warm roof built completely dry under the scaffold canopy, with sixteen solar panels to sit integrated into the finish.
July 2026

Insulation and boarding out

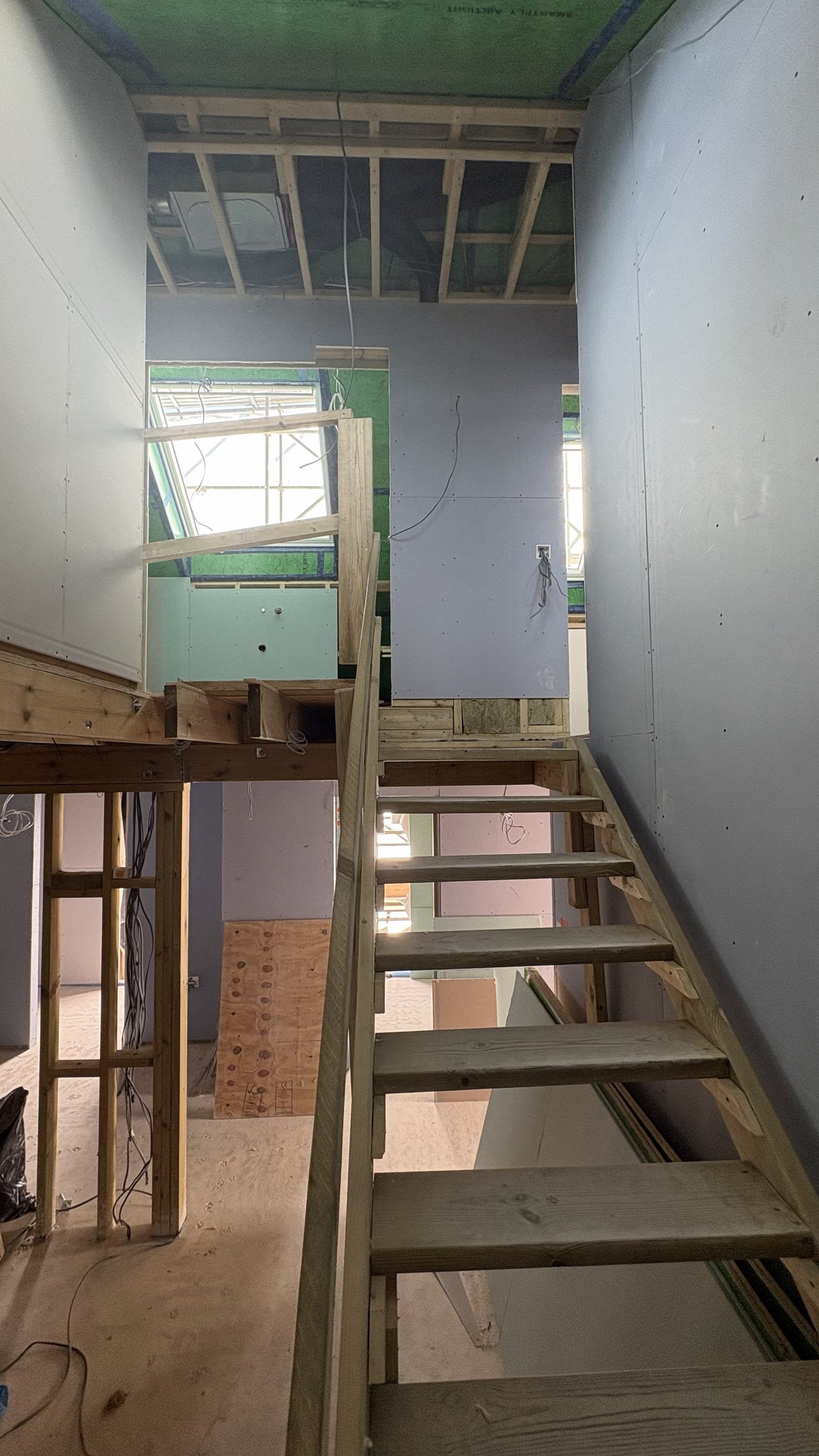

Temporary timber staircase rising through the stairwell
A temporary staircase carries the trades between floors while the house is boarded out. The oak stair is measured and ordered from the finished opening, so it is cut to the building as built rather than to a drawing.

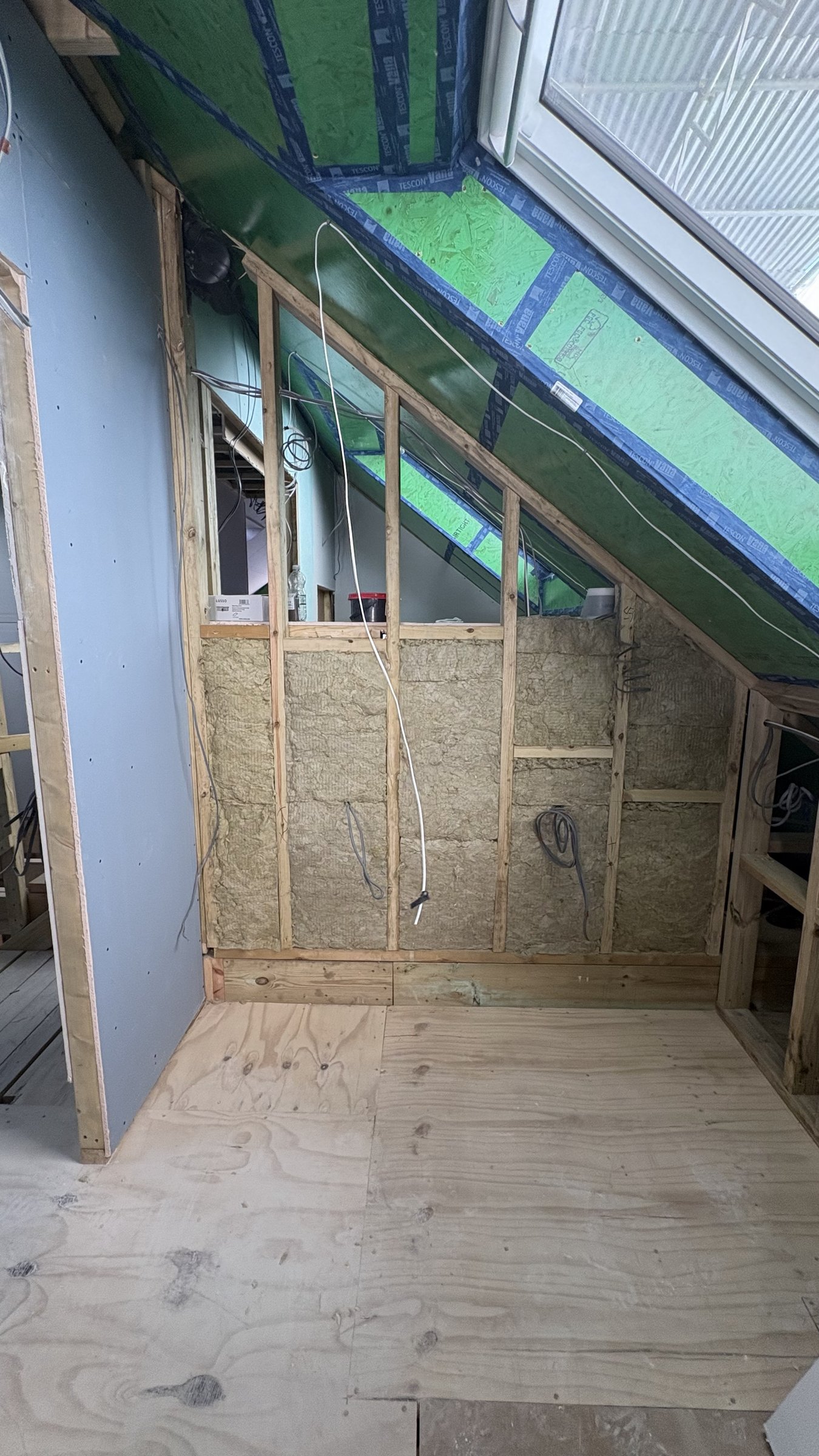

Mineral wool packed into the gable with taped airtight sheathing lining the rafters
Mineral wool in every bay of the gable, the taped airtight layer running continuous across the rafters.

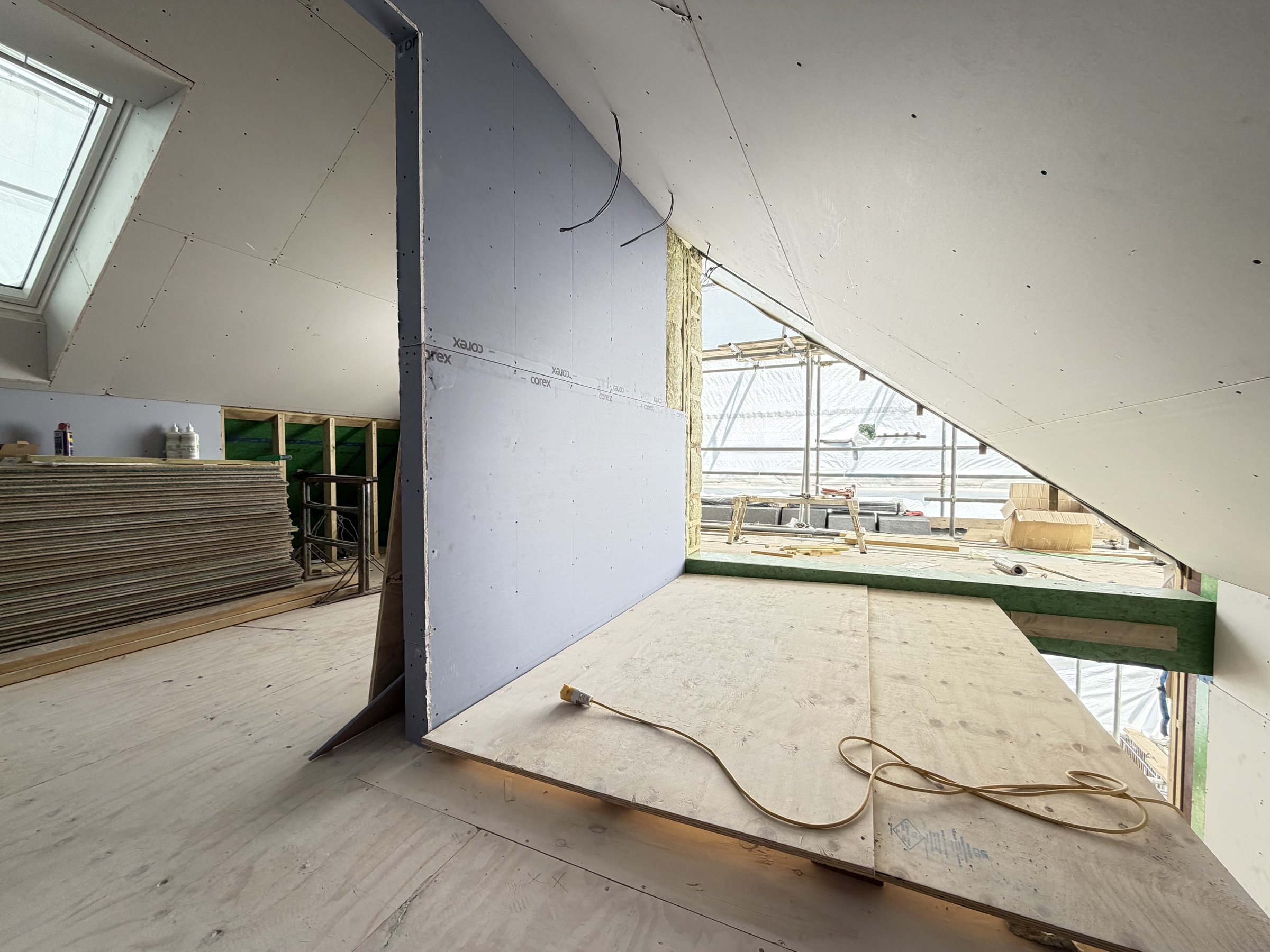

Loft room boarded out to the roofline with rooflights glazed and more plasterboard stacked ready
Plasterboard going up to the roofline in the loft rooms, rooflights glazed and weathertight, more board stacked ready. Nothing skimmed yet. Seven months from bungalow to this, with the fabric doing the work.
August 2026

Slates on, glazing in

Slated roof pitch with a flush solar panel and rooflight, the dormer cheek in black membrane and battens with its window fitted, under the scaffold canopy
The slates are on. Rectangular slates nailed to battens over the counter-battened warm roof, the rooflights sitting flush, and the solar panels set into the slate rather than bolted on top of it. Beside them the dormer cheek is wrapped in breather membrane and battened out for the timber cladding, its window already in.

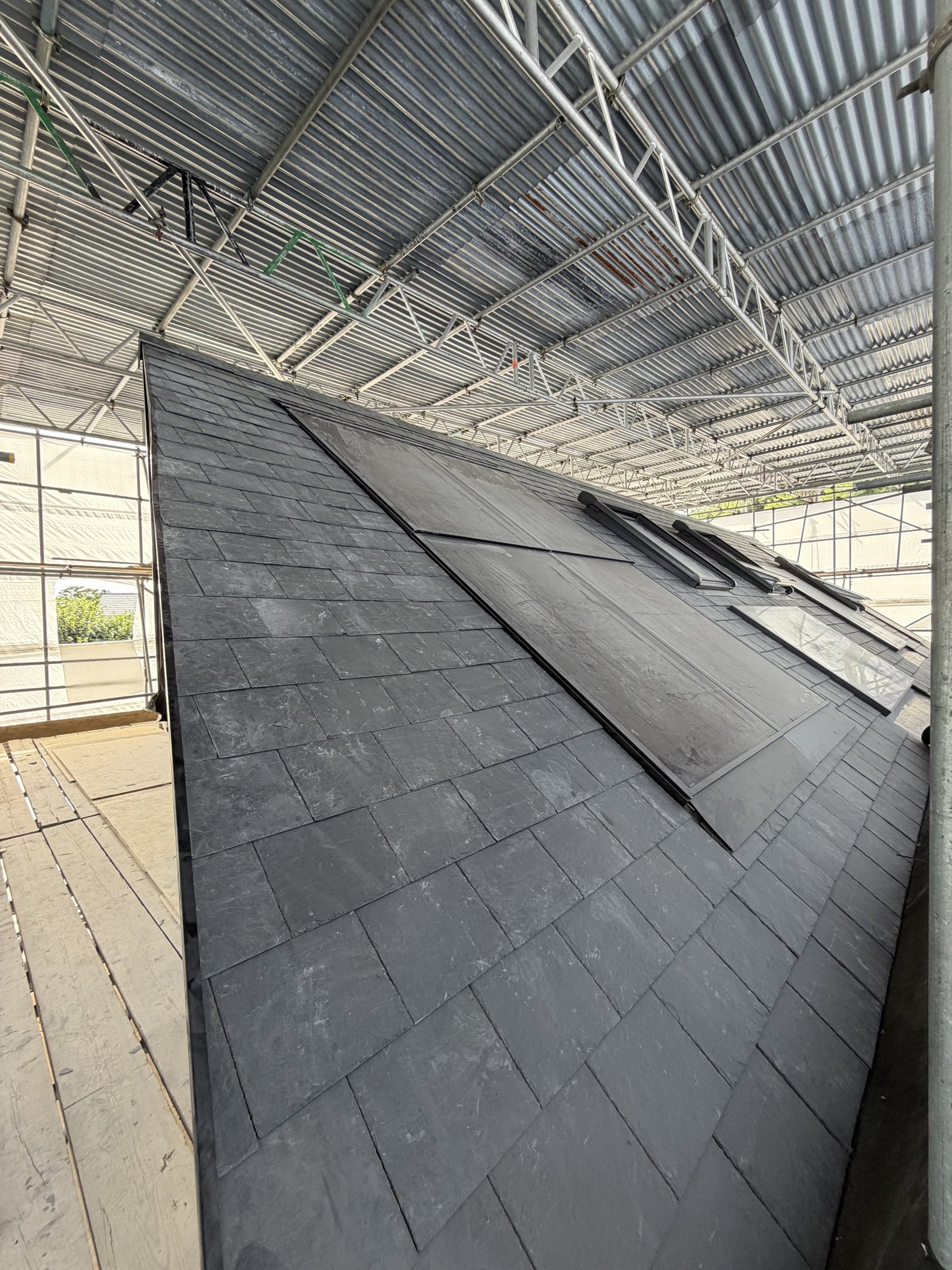

Two in-roof solar panels set flush in the rectangular slates, a rooflight beyond
Integrated solar. The panels sit in the plane of the roof and the slates run up to them, the same way they meet a rooflight. Sixteen of these feed a battery in the plant room.
Black aluminium window frame taped on all four sides to the green airtight board with blue airtightness tape
Every window frame is taped to the airtight board on all four sides before any plasterboard goes near it. This is the joint a blower-door test finds if it is missed, and it is why the first-fix cables run in front of the board rather than through it.

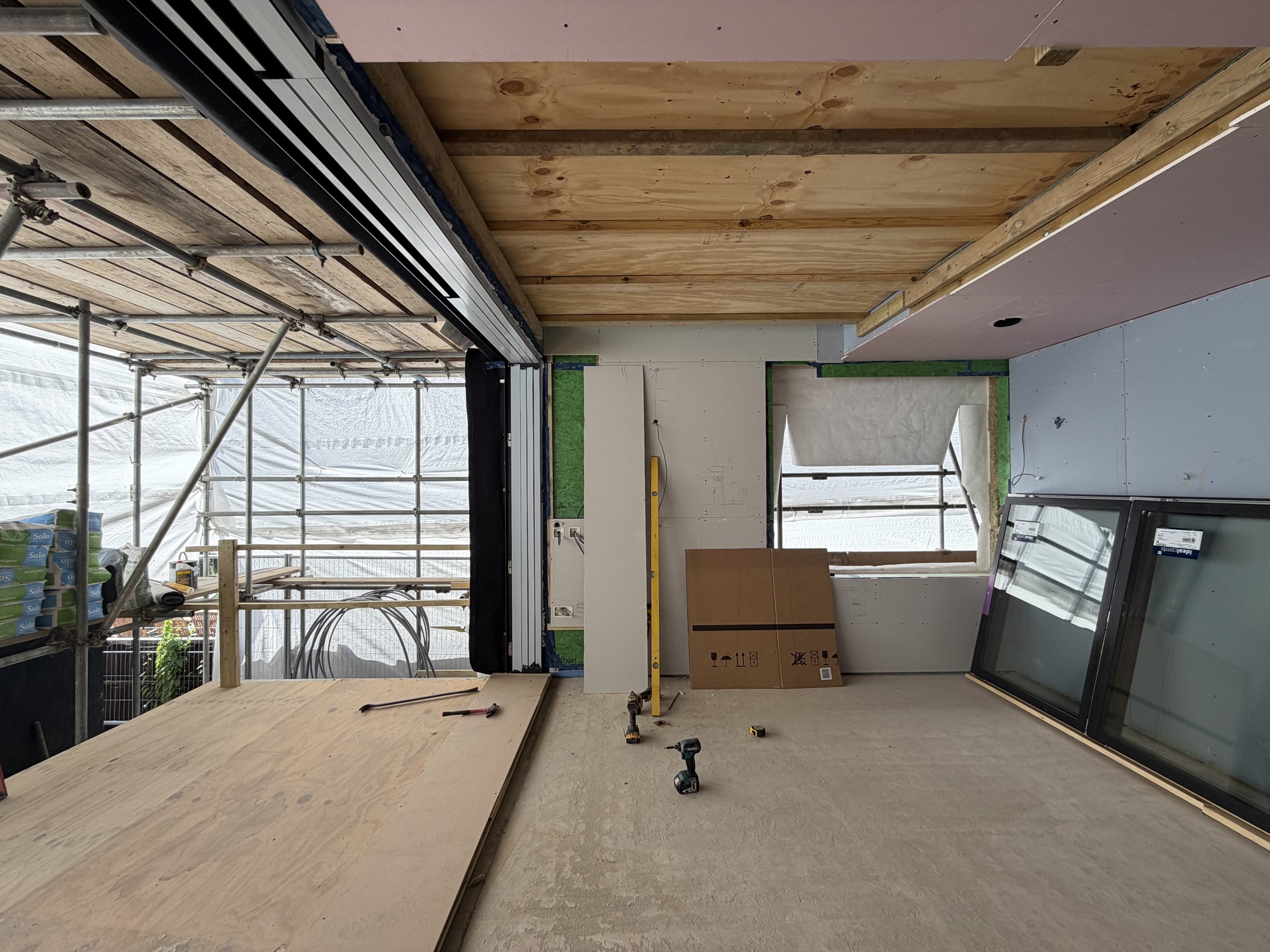

The sliding door frame installed, the opening clear to the plywood-decked rear terrace, exposed ceiling joists over the room
The frame for the sliding doors is in, the opening standing clear to the rear deck until the door leaves arrive. The glazing specialist’s own fitters install them; ours is the structure over the opening, the deck framing beyond it, the threshold beneath and the airtight seal around the frame.

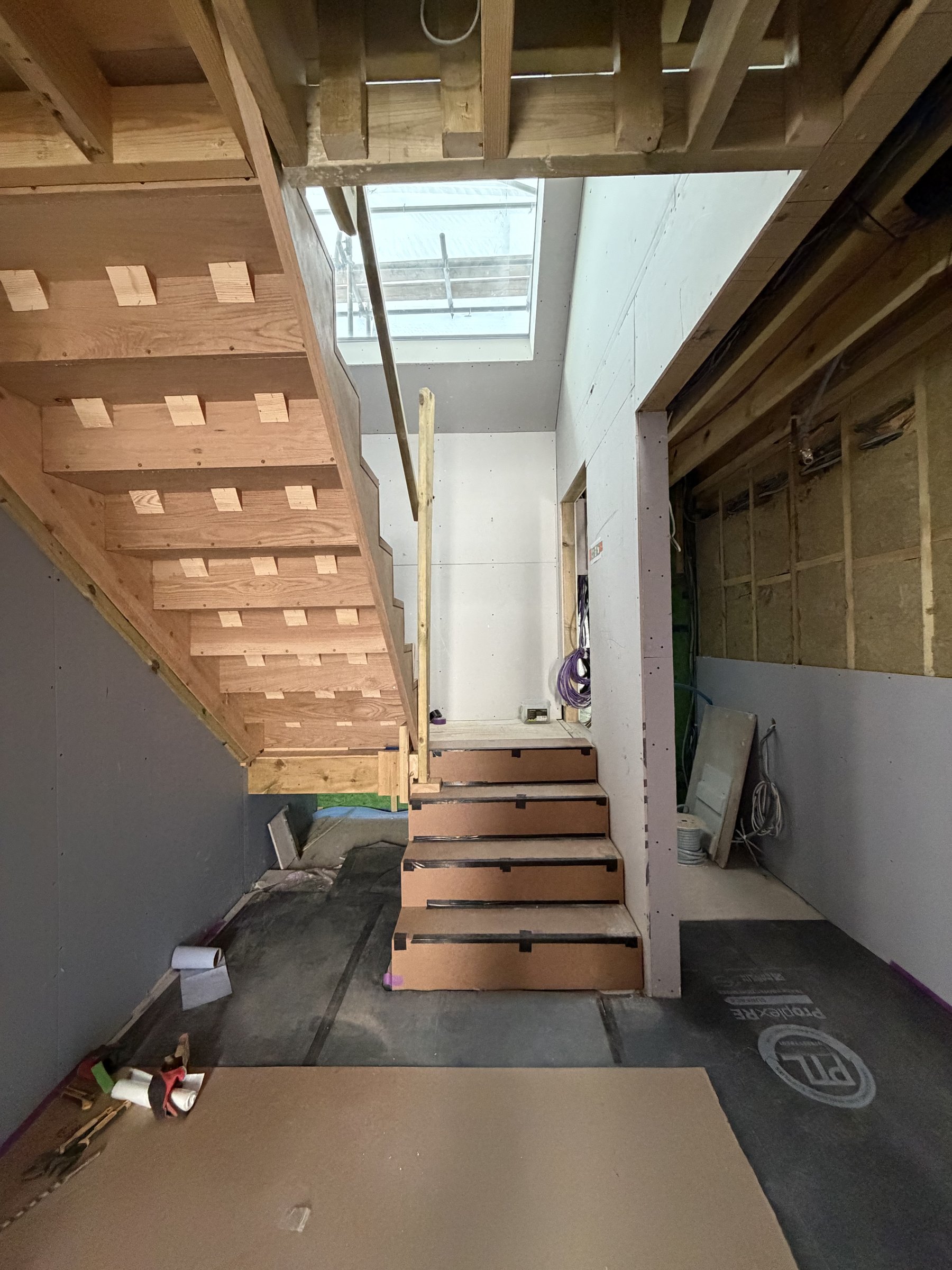

Solid oak staircase with its underside exposed rising past a rooflit stairwell, treads under protective board
The oak stair, made by the stair specialist to the opening as built and now in place, treads boarded over until the decorators are done. The underside is exposed and stays that way, as drawn, so the joinery is the ceiling.

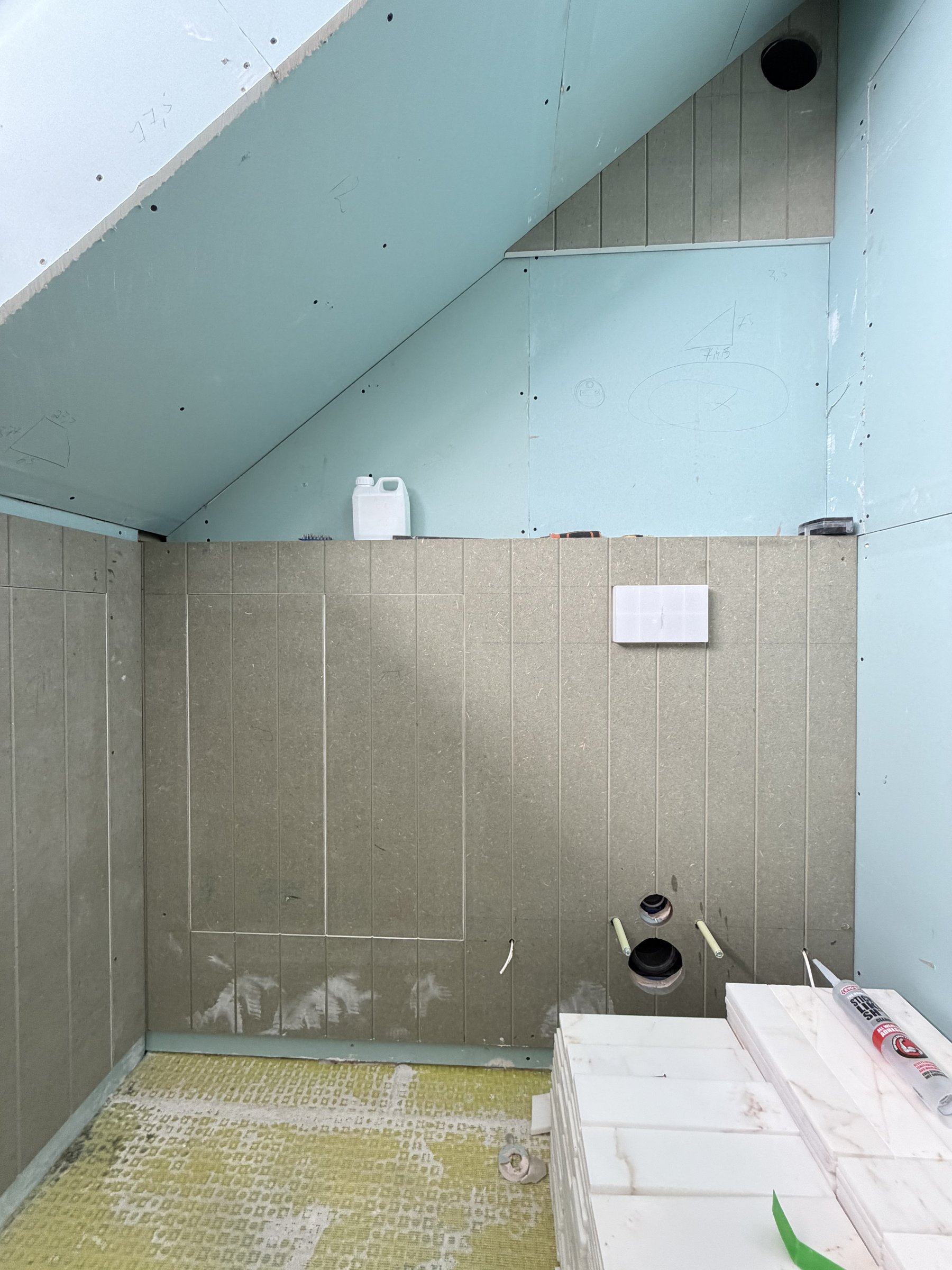

Loft bathroom with tile backer board to the lower walls, decoupling mat on the floor and tiles stacked ready
The loft bathroom ahead of the tiler: tile backer board to the wet walls, a decoupling mat over the floor, the wall-hung frame boxed in and the tiles stacked ready to set out. Everything the tiles will hide is done properly first.
September 2026

Cladding on, first finishes in

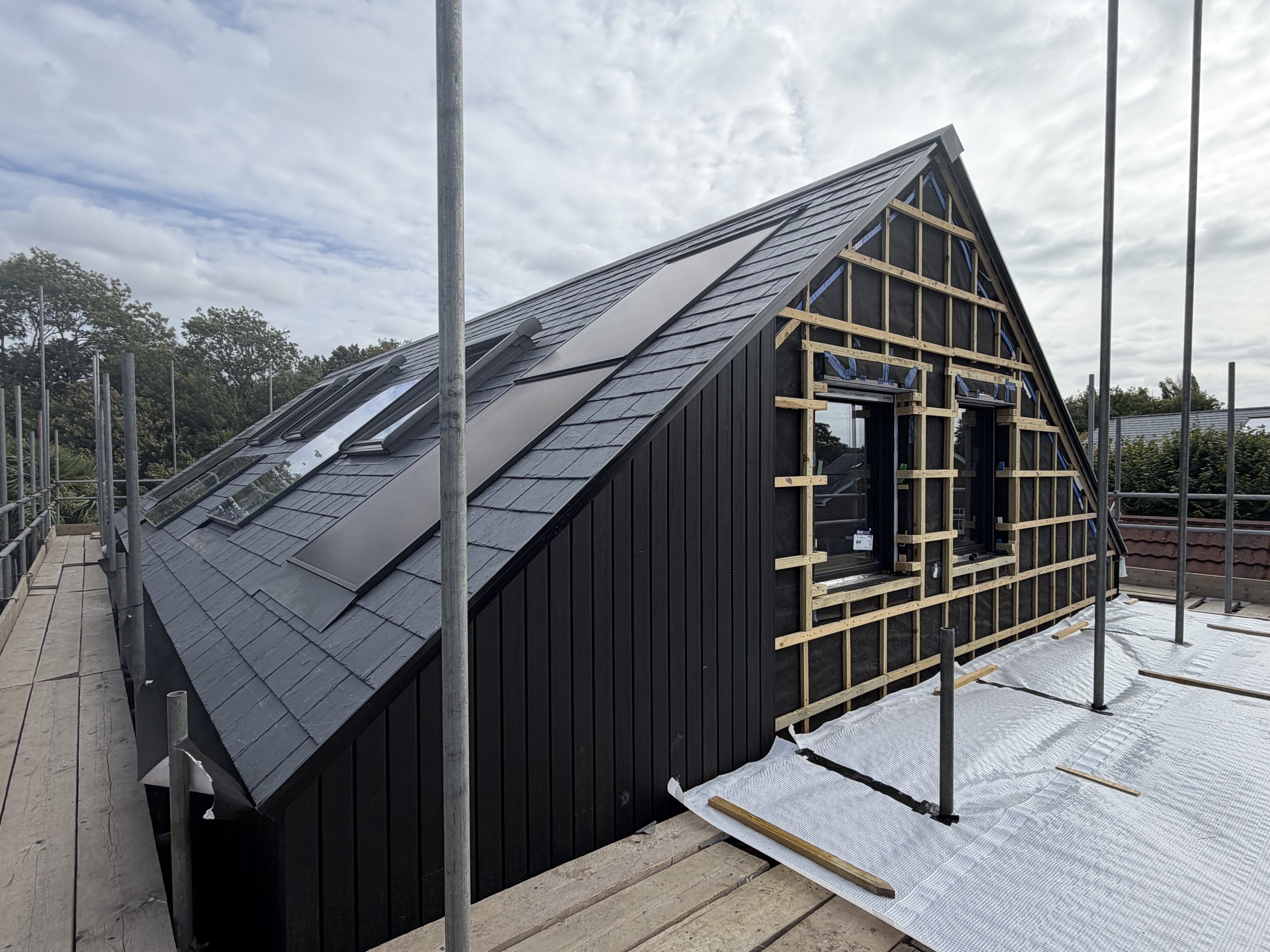

The slated roof in daylight with flush solar panels and rooflights, black vertical timber cladding to the side wall and the gable battened out around two windows
The scaffold roof is off, and for the first time since March the house stands in daylight. Slate to the pitch with the solar panels and rooflights flush in it, charred timber cladding to the wall below, and the gable still in battens around its two windows, waiting for its boards.

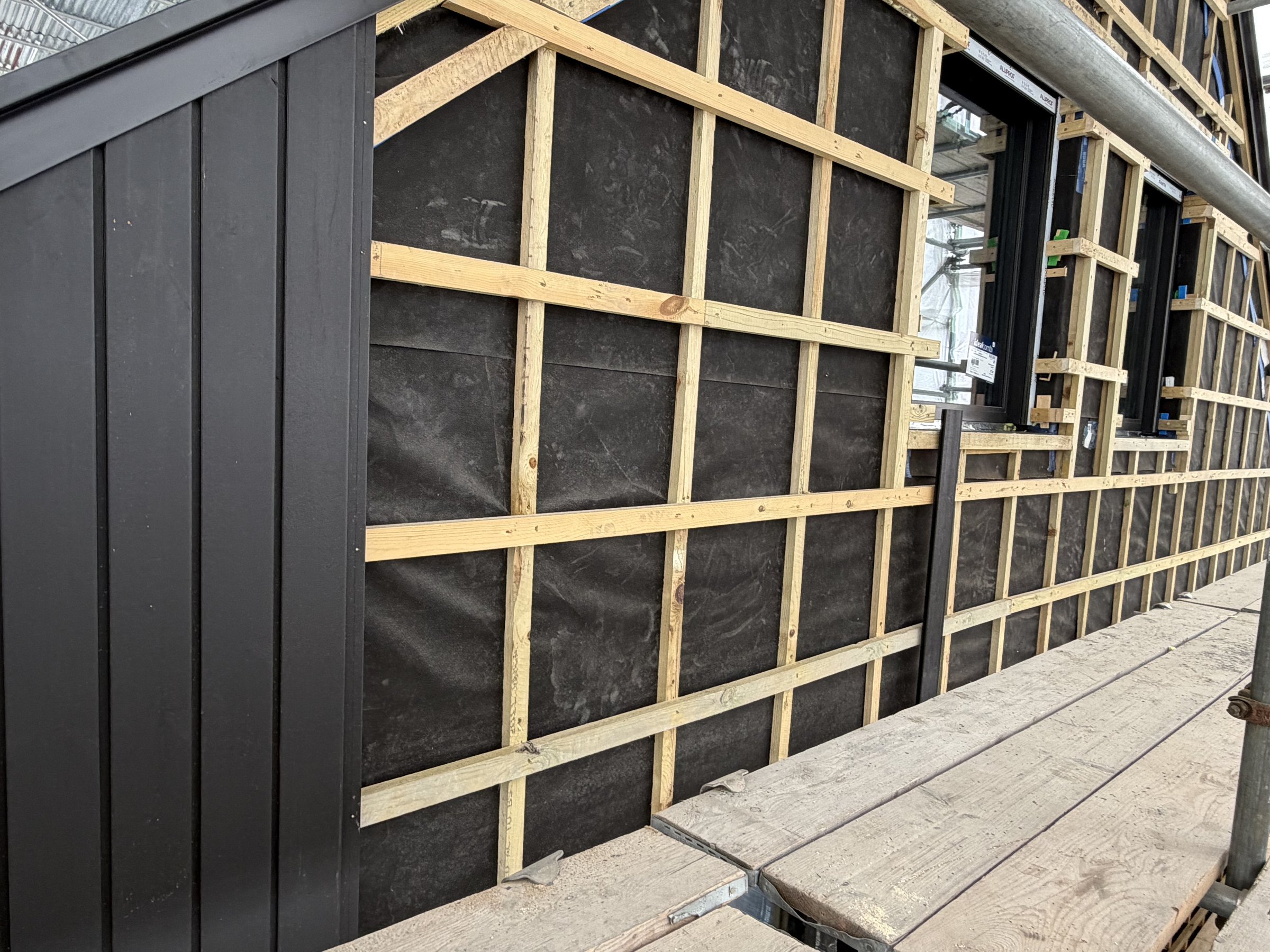

Black vertical cladding boards fixed beside a grid of timber battens over black breather membrane, windows beyond
The cladding going on. Charred timber boards run vertically over a grid of counter battens and battens, open jointed and fixed with black stainless screws. It is a rainscreen: the boards take the weather, the ventilated gap behind them lets anything that gets past drain and dry, and the breather membrane is the line behind that.

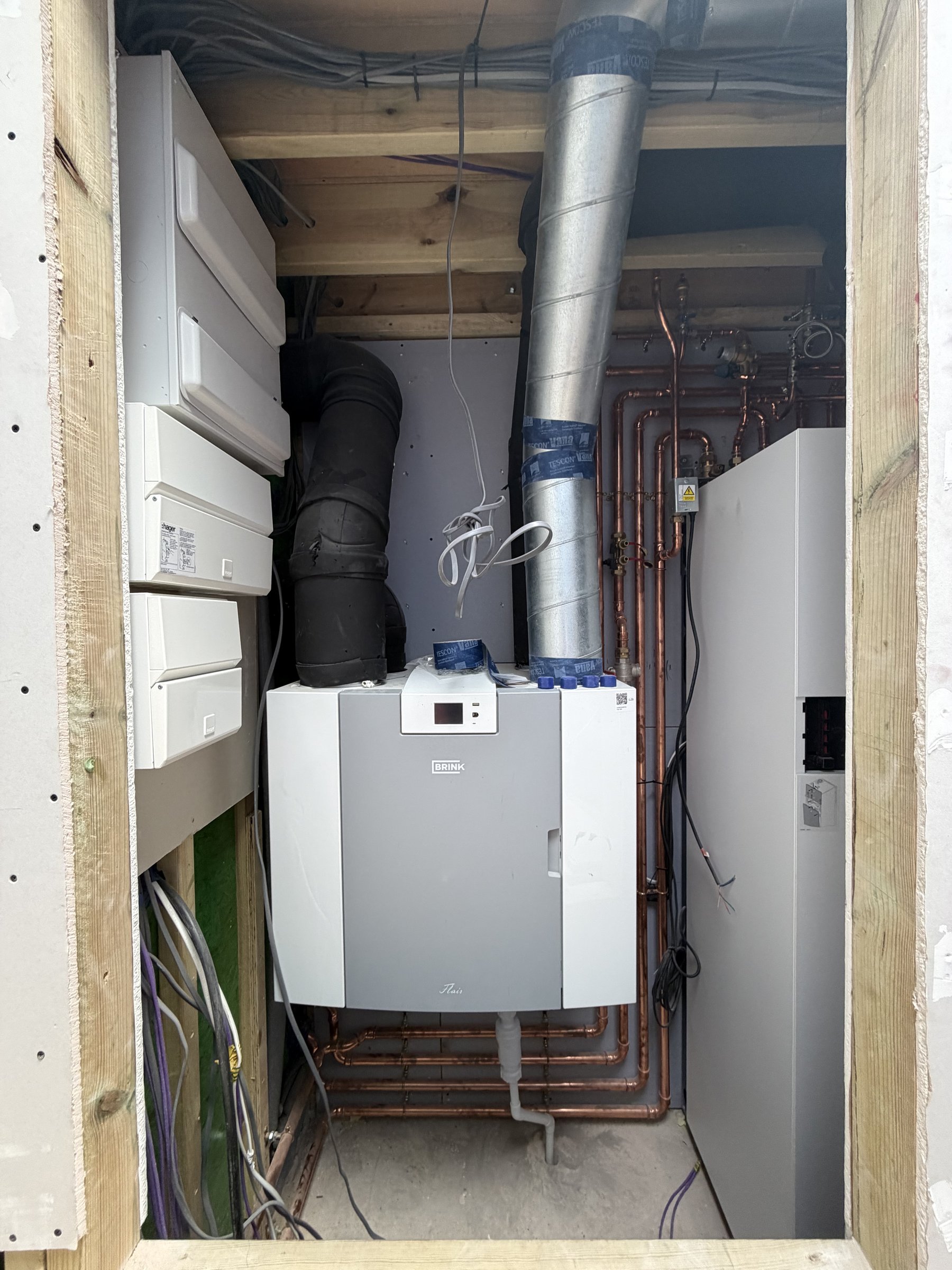

Heat recovery ventilation unit in the plant cupboard with taped ducts above it and copper heating pipework beside it
The heat recovery ventilation unit in the plant cupboard, its ducts taped at the joints, copper heating pipework beside it. It runs all year, taking the warmth out of the stale air leaving the kitchen and bathrooms and putting it into the fresh air coming in. Our mechanical specialist installs and commissions it; ours is the cupboard, the routes through the frame and the airtight seal wherever a duct crosses the line.

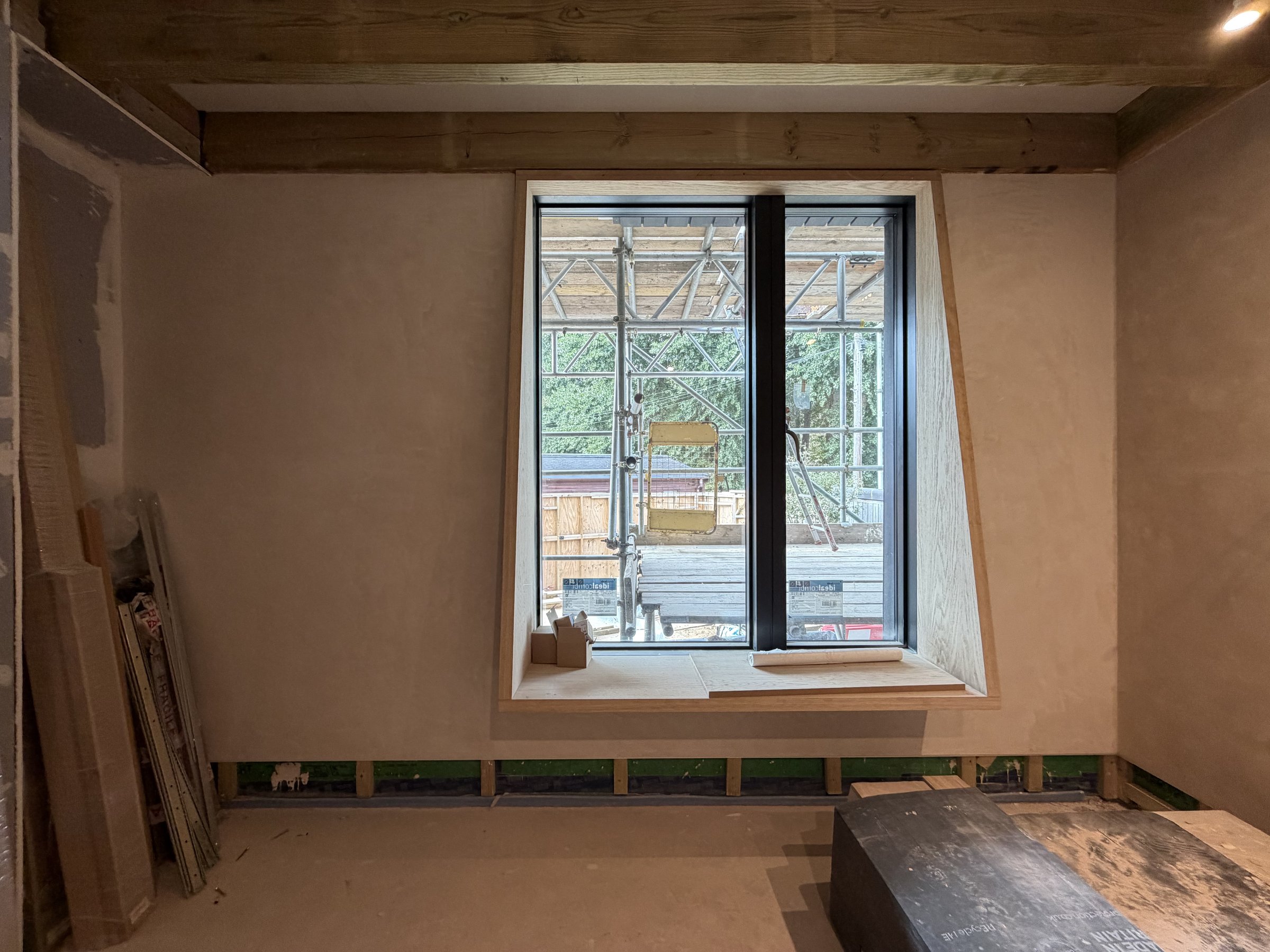

A window with splayed oak-lined reveals and a deep oak sill forming a window seat, set in lime-plastered walls under exposed timber joists
A window seat lined in oak. The reveals splay into the room so the depth of the wall brings light in rather than shading it, and the sill is deep enough to sit on. The walls around it are skimmed in lime plaster and stay unpainted. At the skirting line the green airtight board still shows, the last place it can be seen before the skirting covers it.

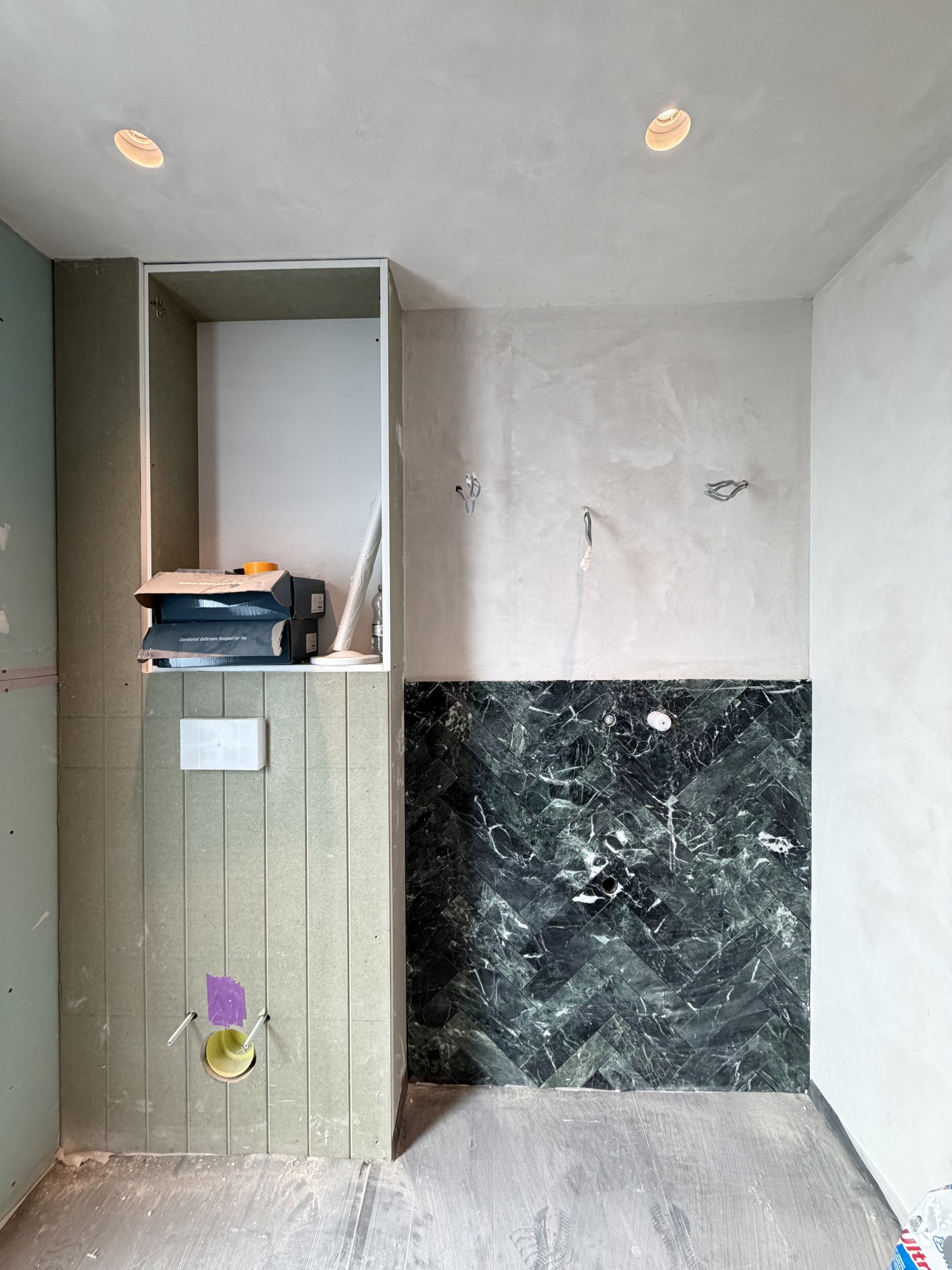

Ground floor cloakroom with green honed marble laid in herringbone behind the vanity, lime-plastered walls and ceiling above, and a V-groove panelled box for the WC frame
The ground floor cloakroom. Green honed marble laid in herringbone behind the vanity, lime plaster above it and across the ceiling. The WC frame is boxed in moisture-resistant MDF with a V-groove face, bare for now and painted later.

Loft bathroom with herringbone marble to the shower and the sloping ceiling, a black and white marble floor laid on the diagonal, V-groove panelling and a rooflight
The loft bathroom, tiled. Calacatta Amber marble in herringbone to the shower, carried up the slope of the roof, and black and Calacatta Amber marble squares laid on the diagonal across the floor. The V-groove panelling is moisture-resistant MDF, bare until it is painted.

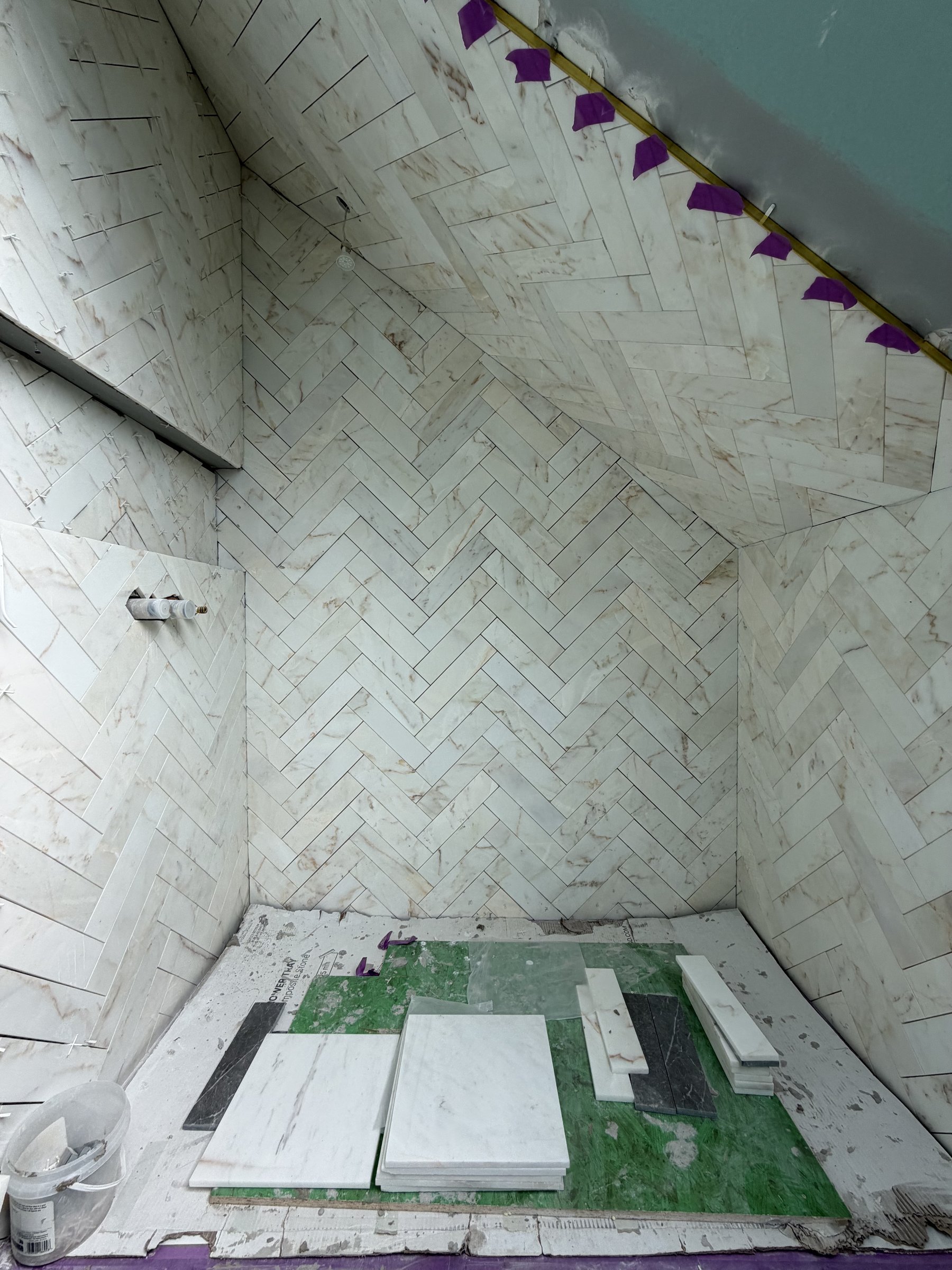

Inside the loft shower, herringbone marble running from the wall onto the sloping ceiling, floor tiles stacked on the green waterproofing
Inside the loft shower. The herringbone is set out to run unbroken from the wall onto the sloping ceiling, and the floor tiles are stacked on the waterproofing, ready to go down next.
October 2026

Gables clad, joinery in

Black vertical timber cladding covering a full gable up to the verge, two dark-framed windows set into it, blue sky behind and a scaffold tube in the foreground
The gable that was still in battens last month, boarded up to the verge in the same charred timber as the wall below. Black screws into black boards, dark window frames set into the reveals, slate on the next pitch behind.
Rear gable with charred black boards folded over as a deep verge, the recess beneath lined in pale vertical boards on wall and soffit, a large window under the slope and a scaffold platform in front
The rear gable turns the other way. The charred boards fold over the top as a deep verge, and the recess under them is lined in paler boards with a sioo:x coating: wall, soffit and window reveals all in one material. Nine days before this frame the verge was still open battens and membrane.
First floor room with lime plaster over the sloping ceiling, a large rooflight, an oak-lined recess, bare V-groove panelling, stacked oak floorboards, and green airtight board visible through an eaves opening
Lime plaster on the first floor, skimmed over the slopes and round the rooflight and left unpainted. A lot of the build is in this one frame: the green airtight board through the eaves opening, the oak-lined recess that will sit over the bed, V-groove panelling in bare moisture-resistant MDF, and the oak floorboards stacked ready to go down.
Dark painted V-groove panelling under a window with oak-lined reveals, a dark column radiator below, bare lime plaster above and white panels to the right beneath an oak-lined recess
Colour starts going on upstairs. V-groove panelling in dark eggshell, with oak linings to the window reveal. The walls above stay in bare lime plaster, because nothing in this house has painted walls: the joinery carries all the colour. The panels to the right are still waiting for theirs.
Kitchen under exposed timber joists with dark painted units along two walls, an oak island carcass in the foreground and flat rooflights between the joists above a lime-plastered wall
The kitchen going in under the exposed joists, cabinets by the kitchen supplier. Ours is what they land on: the joists, sized with a charring allowance so they can stay on show, the rooflights between them, the lime plaster, and the power and water brought to where the units need them.
Black and white marble laid on the diagonal at the foot of a stair, protection board taped over the middle of the floor and over the stair treads, lime-plastered walls and ceiling
Honed black and white marble laid at 45 degrees at the foot of the stair, the middle of the floor under protection board from the moment it was down. The stair treads are boarded over the same way. Everything finished from here gets covered, because the last trades still have to walk across it.
Shower lined in green marble herringbone on three walls, a niche recessed into the pattern and a brass shower set on the back wall
The ground floor shower with its brassware on. Green honed marble in herringbone on all three walls, a niche recessed into the pattern, and the brass shower set run up the back wall. September showed the same stone behind the cloakroom vanity.
Black composite deck frame on adjustable pedestals over a concrete platform beside the River Thames, a temporary timber rail along the water and a brick retaining wall to the right
Down at the river, the frame for the deck: a composite base on adjustable pedestals over the retained concrete platform, with the boards to follow. Behind it the new retaining wall in engineering brick, capped brick on edge to match the plinths of the house. The timber rail along the water is temporary, there for the works.
The other build

Built twice: first in the model

Every scheme we take on gets built twice. Alongside The Vawdrey House’s design, our team builds the whole house as a 3D model in-house: every steel, stud, nogging, and thermal break, down to the bolts. It is how we make sure everything connects before anyone builds it, and how problems get flagged on a screen rather than found on the scaffold. These drawings are working sketches from our own model of Black House.

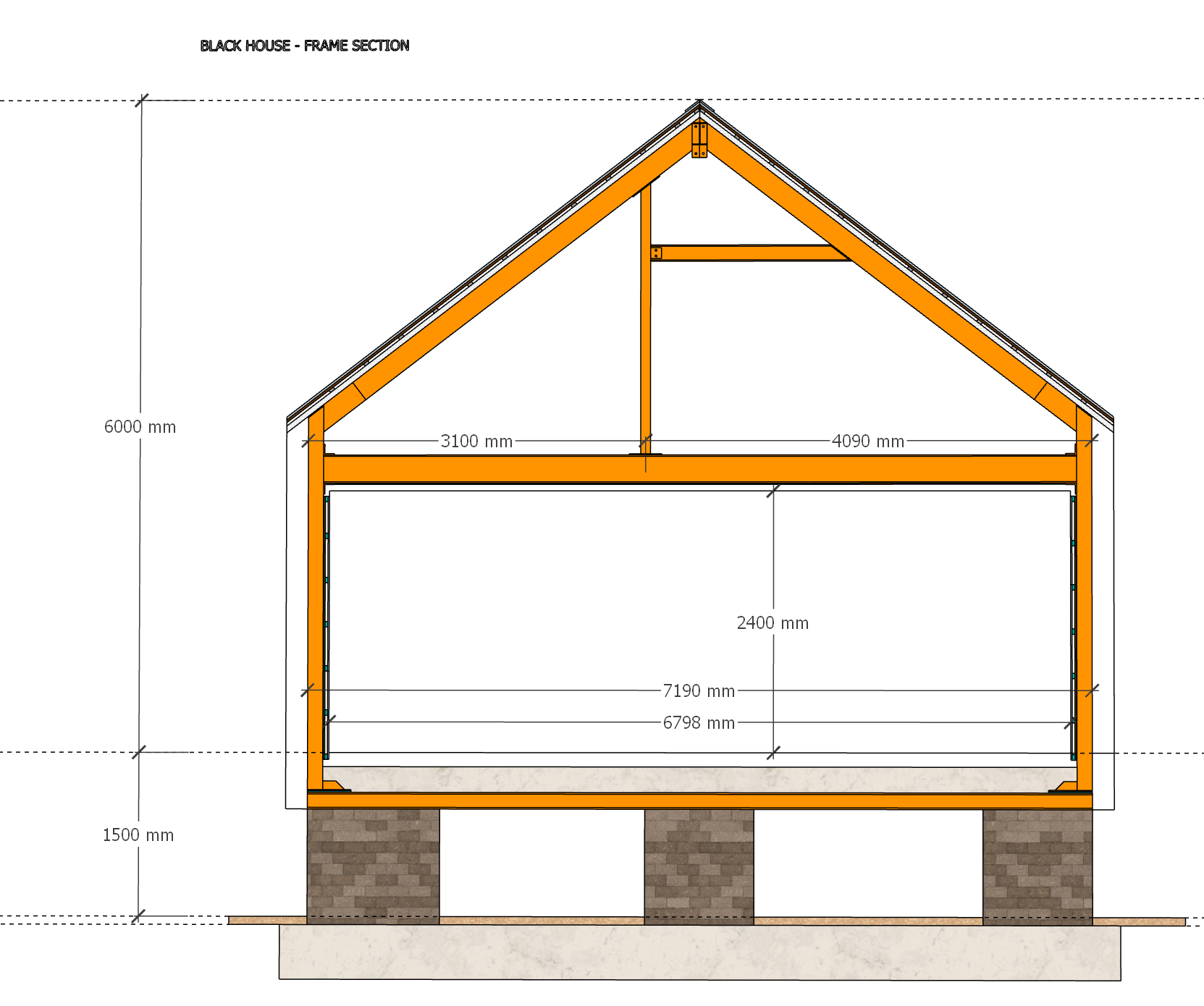

Black House frame section drawing from the Omniform model
The frame section: steel and timber over the brick plinths, drawn by us before it was built.

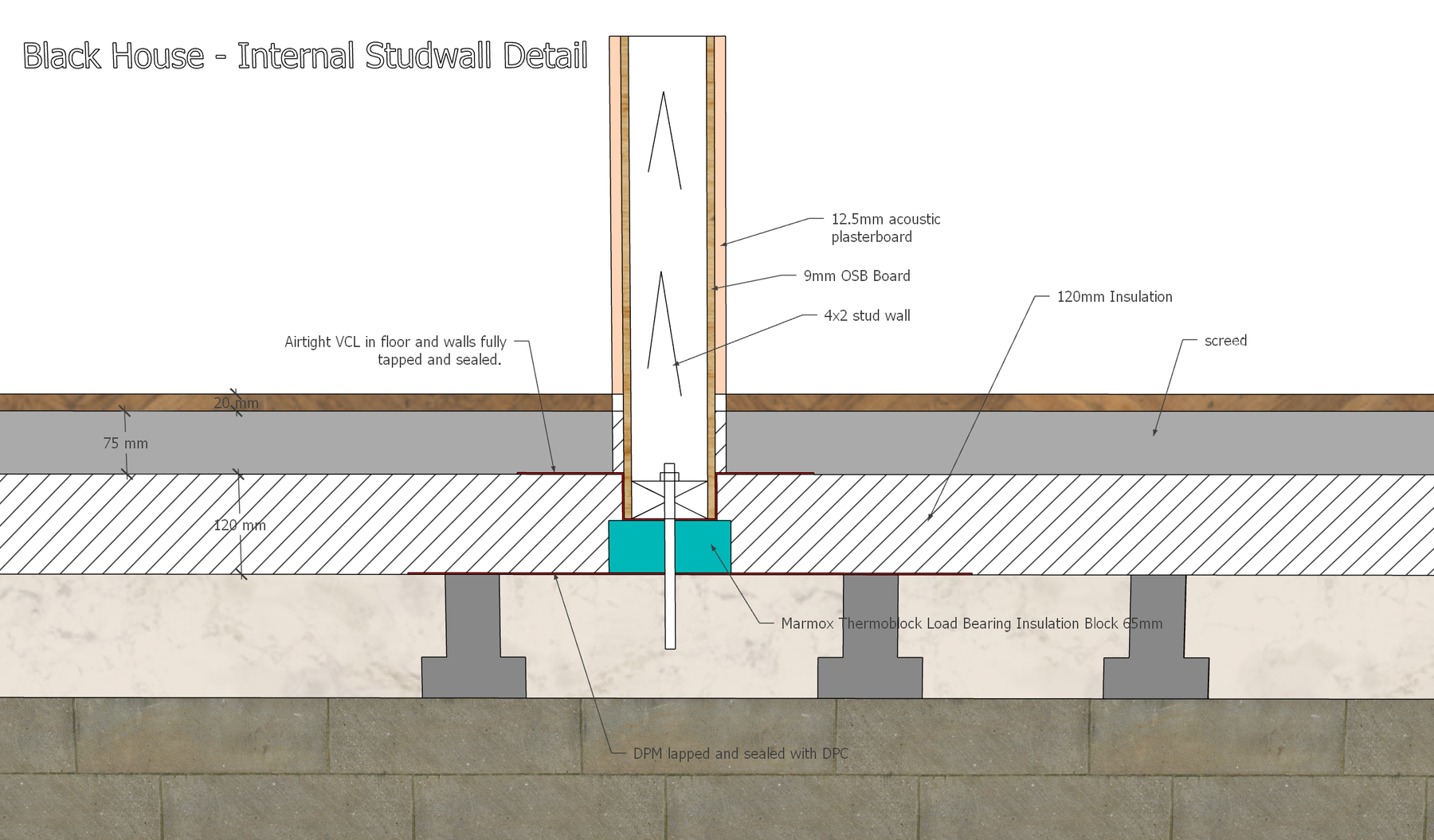

Internal studwall base detail with a loadbearing thermal block
The studwall base detail: a loadbearing insulation block under every internal stud, the airtight layer taped through the junction, the DPM lapped and sealed.

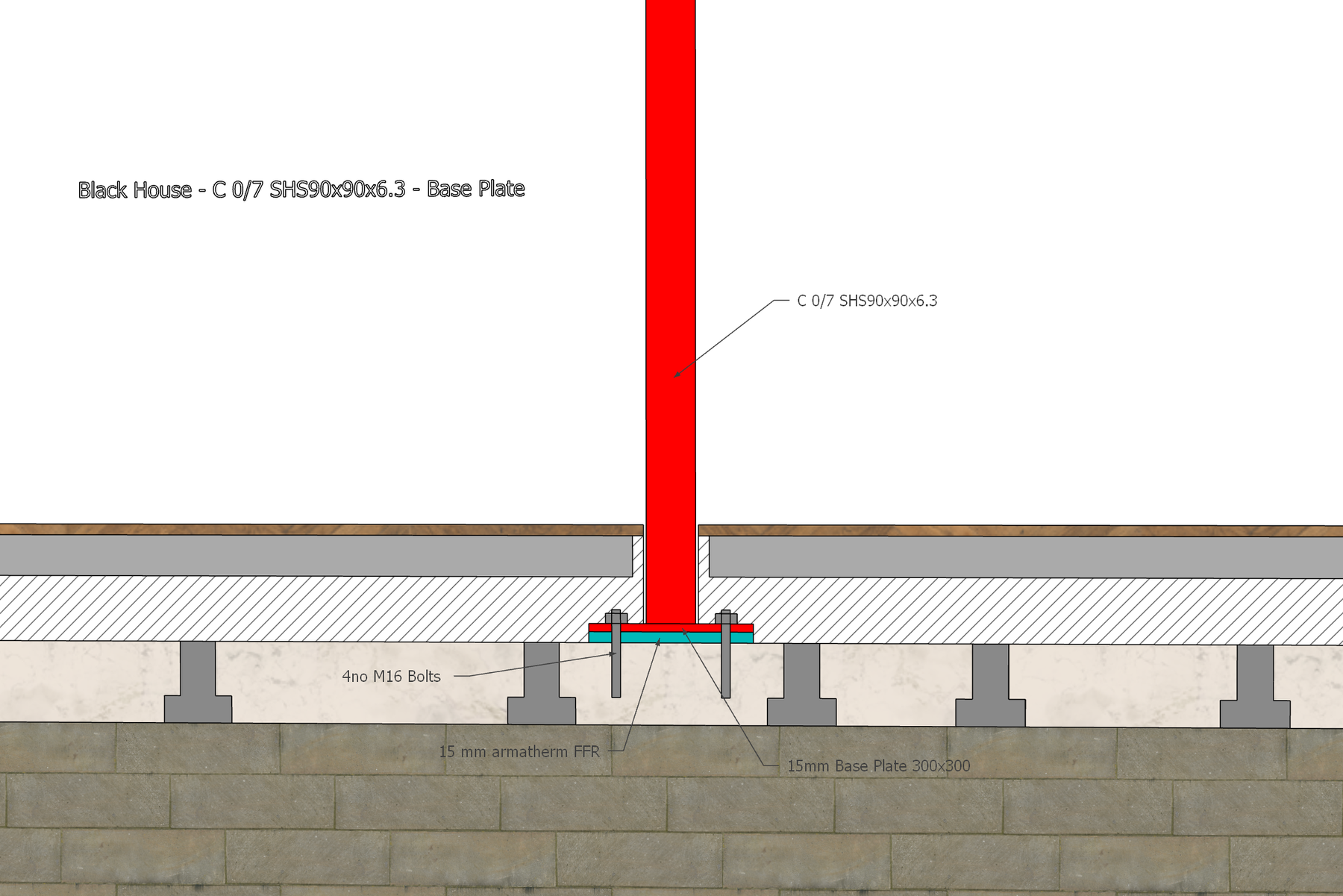

Steel column base plate detail with a thermal break beneath the plate
A steel column base plate on 15mm of structural thermal break, so even the frame’s feet never bridge the insulation line.

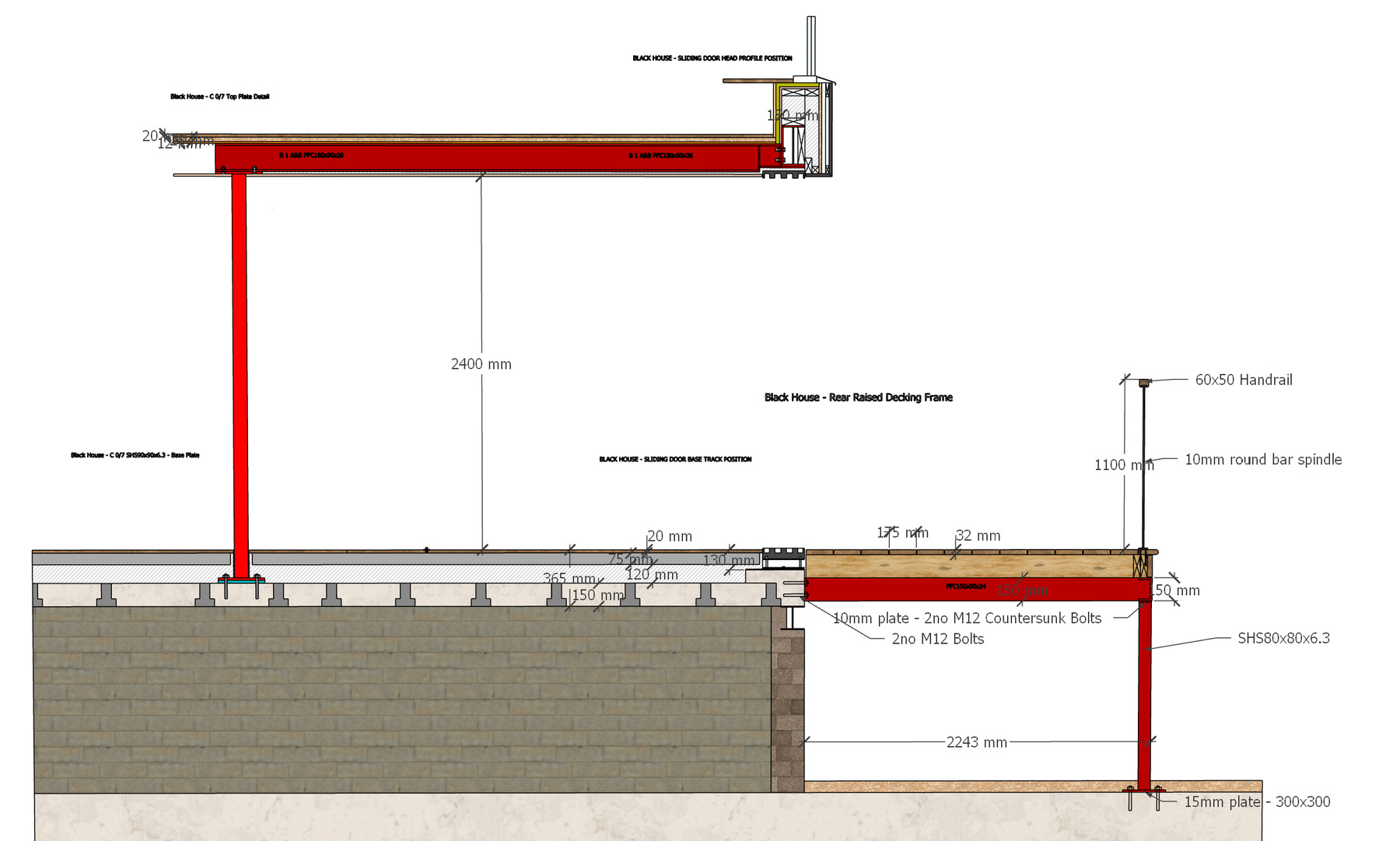

Rear deck and sliding door sections from the Omniform model
The rear deck frame and sliding door positions worked through in section: track heights, steel sizes, fixings, and the handrail, resolved together rather than trade by trade.

The build continues. New months are added as the work moves on. With the gables clad, lime plaster on the first floor and the joinery going in, the next update follows the oak floors going down and the painting carried through the rooms.
